Pictures of Recent Work
January 12, 2017
Posted on April 21st, 2017
![January 12, 2017](https://www.srsnesite.com/wp-content/uploads/2017/04/SRSNE-1-12-2017-26-of-26.jpg)
January 12, 2017
![January 12, 2017](https://www.srsnesite.com/wp-content/uploads/2017/04/SRSNE-1-12-2017-19-of-26.jpg)
January 12, 2017
Site Demobilization February to April, 2015
Posted on May 1st, 2015

![De-mobilization from site on Feb. 23, 2015.](https://www.srsnesite.com/wp-content/uploads/2015/05/2-23-2015-300x169.jpg)
De-mobilization from site on Feb. 23, 2015.

![De-mobilization from site on March 29, 2015.](https://www.srsnesite.com/wp-content/uploads/2015/05/3-9-2015-300x169.jpg)
De-mobilization from site on March 29, 2015.

![De-mobilization from site on March 30, 2015.](https://www.srsnesite.com/wp-content/uploads/2015/05/3-30-2015-300x168.jpg)
De-mobilization from site on March 30, 2015.
![De-mobilization from site on April 17, 2015.](https://www.srsnesite.com/wp-content/uploads/2015/05/4-17-2015-300x168.jpg)
De-mobilization from site on April 17, 2015.

![De-mobilization from site on April 20, 2015.](https://www.srsnesite.com/wp-content/uploads/2015/05/4-20-2015-300x168.jpg)
De-mobilization from site on April 20, 2015.

![De-mobilization from site on April 29, 2015.](https://www.srsnesite.com/wp-content/uploads/2015/05/4-29-2015-1-300x168.jpg)
De-mobilization from site on April 29, 2015.
In-situ Thermal Remediation Continues
Posted on September 17th, 2014

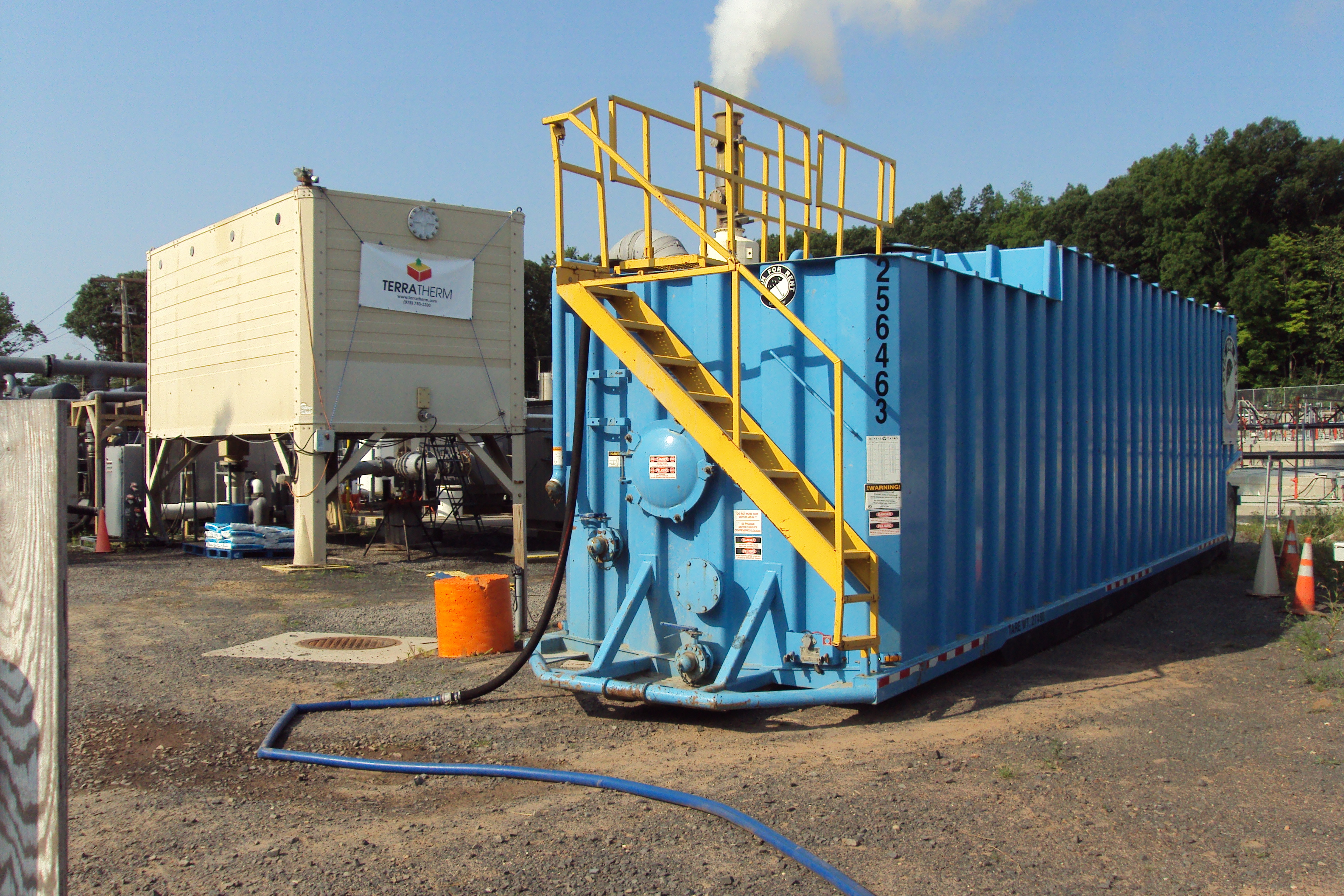

![Frac tank (mobile steel storage tank) for extra discharge water.](https://www.srsnesite.com/wp-content/uploads/2014/09/20140731-DSC02872-tank-for-extra-discharge-water-1024x682.jpg)
Frac tank (mobile steel storage tank) for extra discharge water.

![Repairing the discharge pump on July 31st.](https://www.srsnesite.com/wp-content/uploads/2014/09/20140731-DSC02874-replacing-discharge-pump-1024x682.jpg)
Repairing the discharge pump on July 31st.

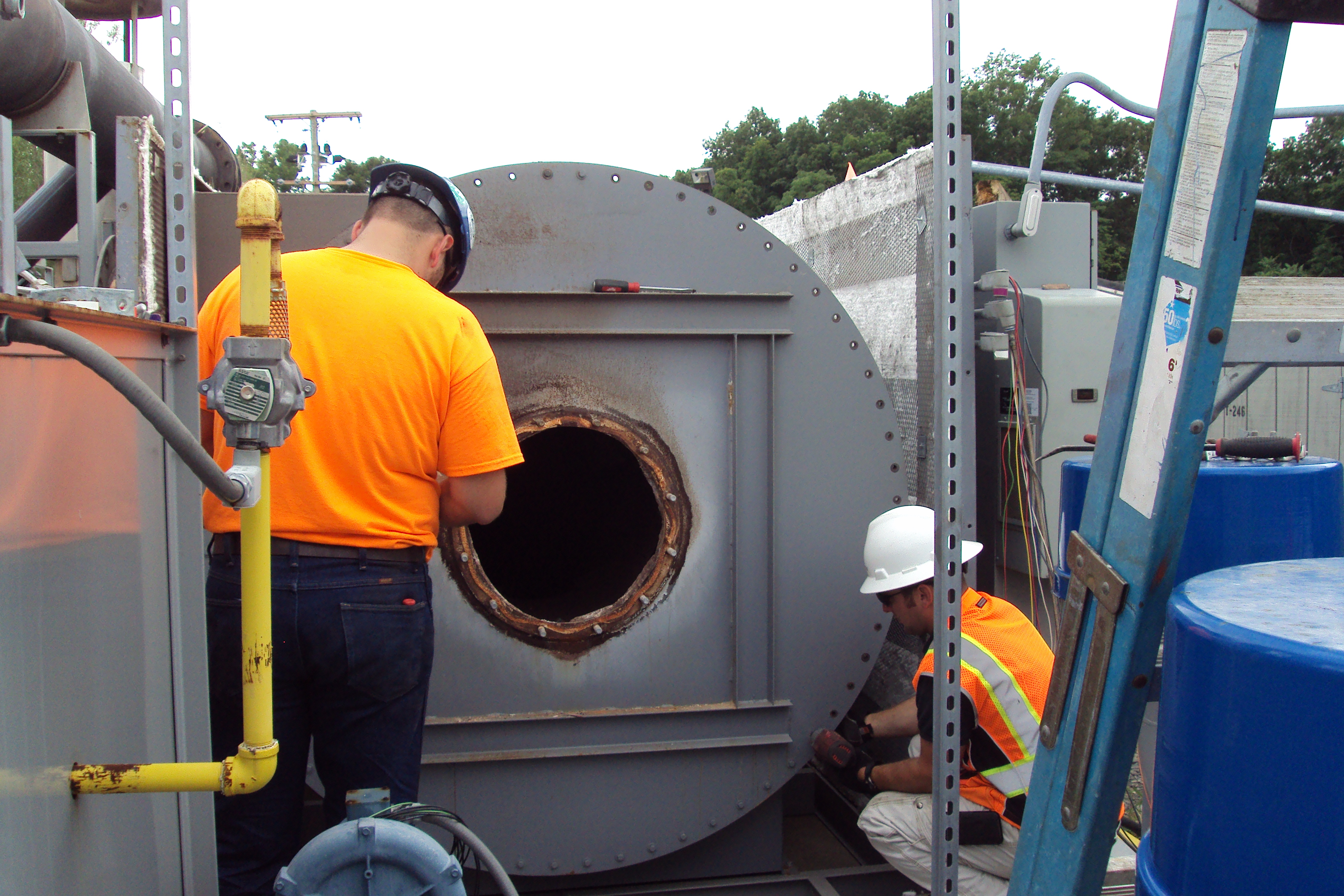

![Repairs completed to the oxidizer in late August.](https://www.srsnesite.com/wp-content/uploads/2014/09/20140821-DSC02889-repairing-the-oxidizer--1024x682.jpg)
Repairs completed to the oxidizer in late August.
July Activities at SRSNE
Posted on July 31st, 2014

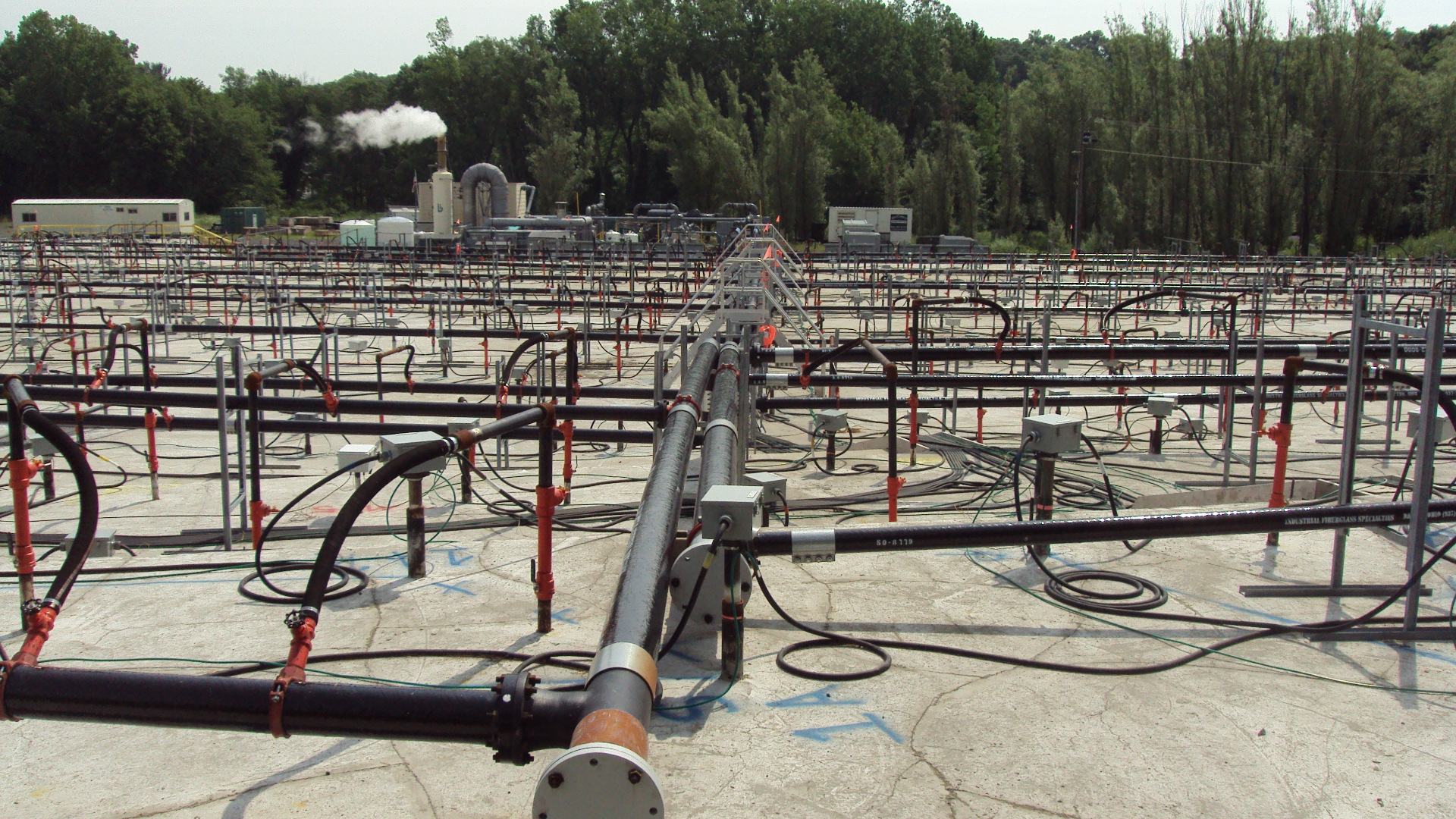

![Wellfield piping.](https://www.srsnesite.com/wp-content/uploads/2014/09/20140708-DSC02772-wellfield-piping-1024x576.jpg)
Wellfield piping.

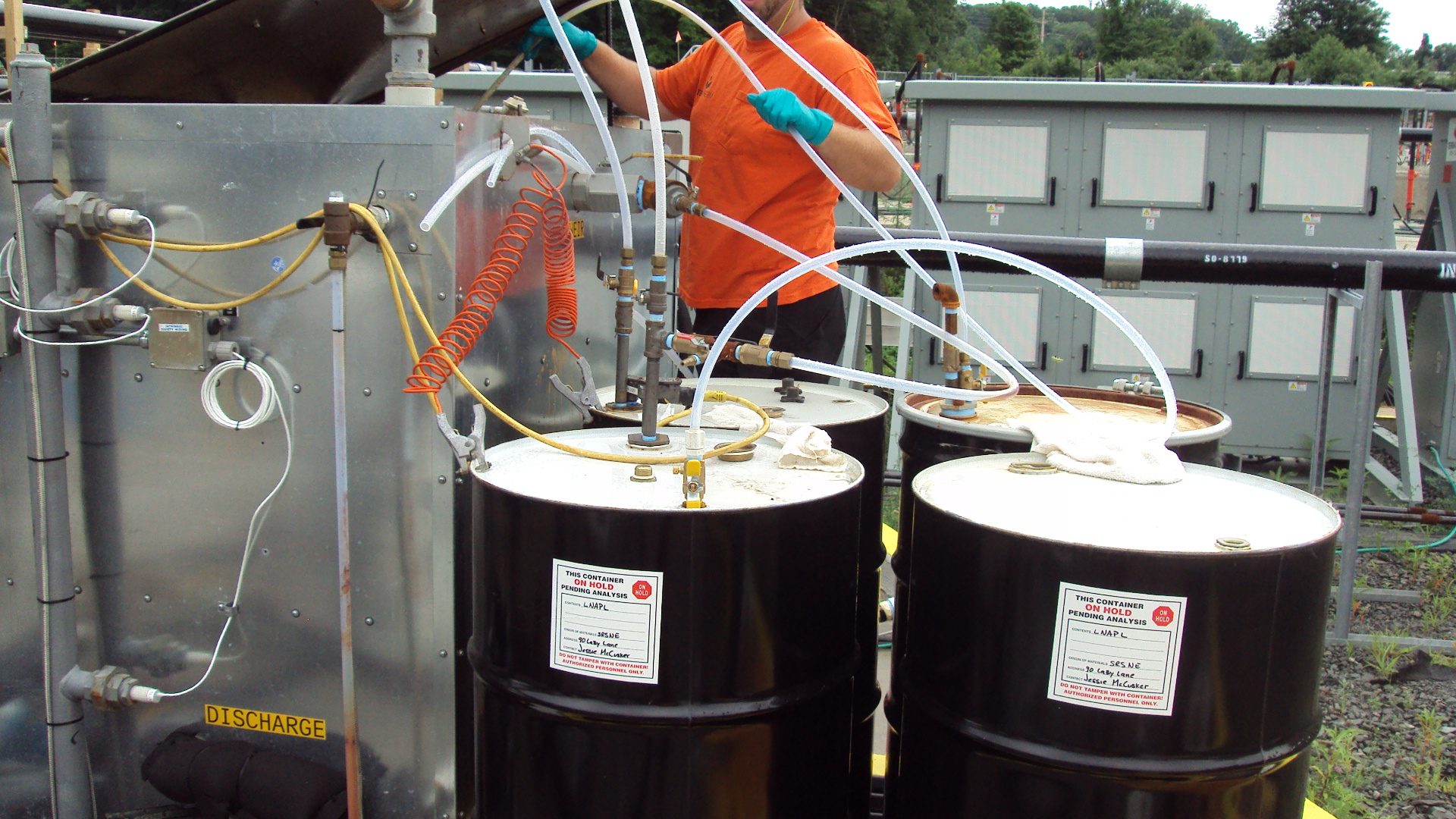

![Decanting Light Non-Aqueous Phase Liquids (LNAPL) from the oil/water separator on 7/16/2014](https://www.srsnesite.com/wp-content/uploads/2014/09/20140716-DSC02832-decanting-LNAPL-1024x576.jpg)
Decanting Light Non-Aqueous Phase Liquids (LNAPL) from the oil/water separator on 7/16/2014

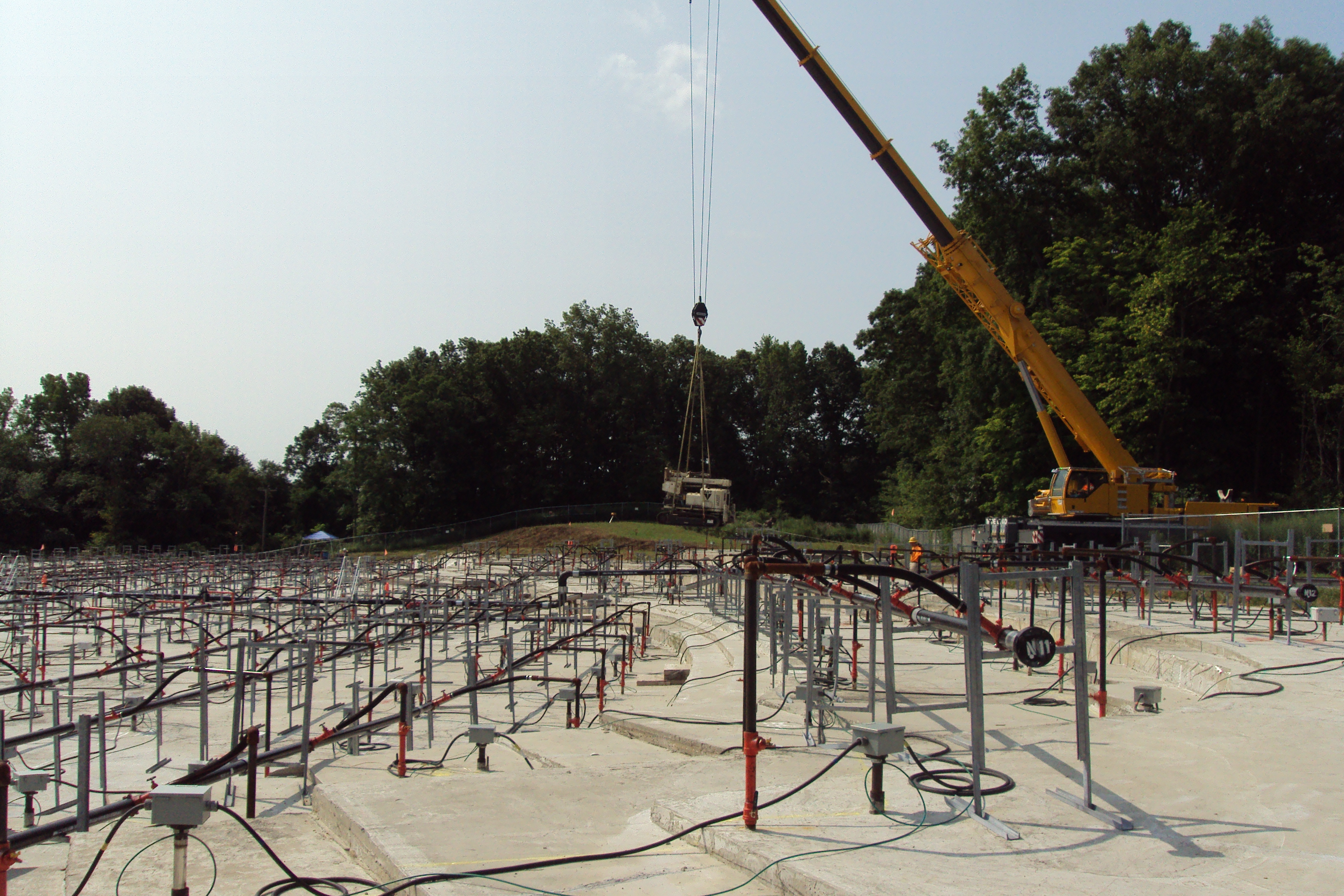

![Placing the Geoprobe, using a crane, onto the wellfield to collect soil samples in late July.](https://www.srsnesite.com/wp-content/uploads/2014/09/20140730-DSC02866-geoprobe-placement-1024x682.jpg)
Placing the Geoprobe, using a crane, onto the wellfield to collect soil samples in late July.

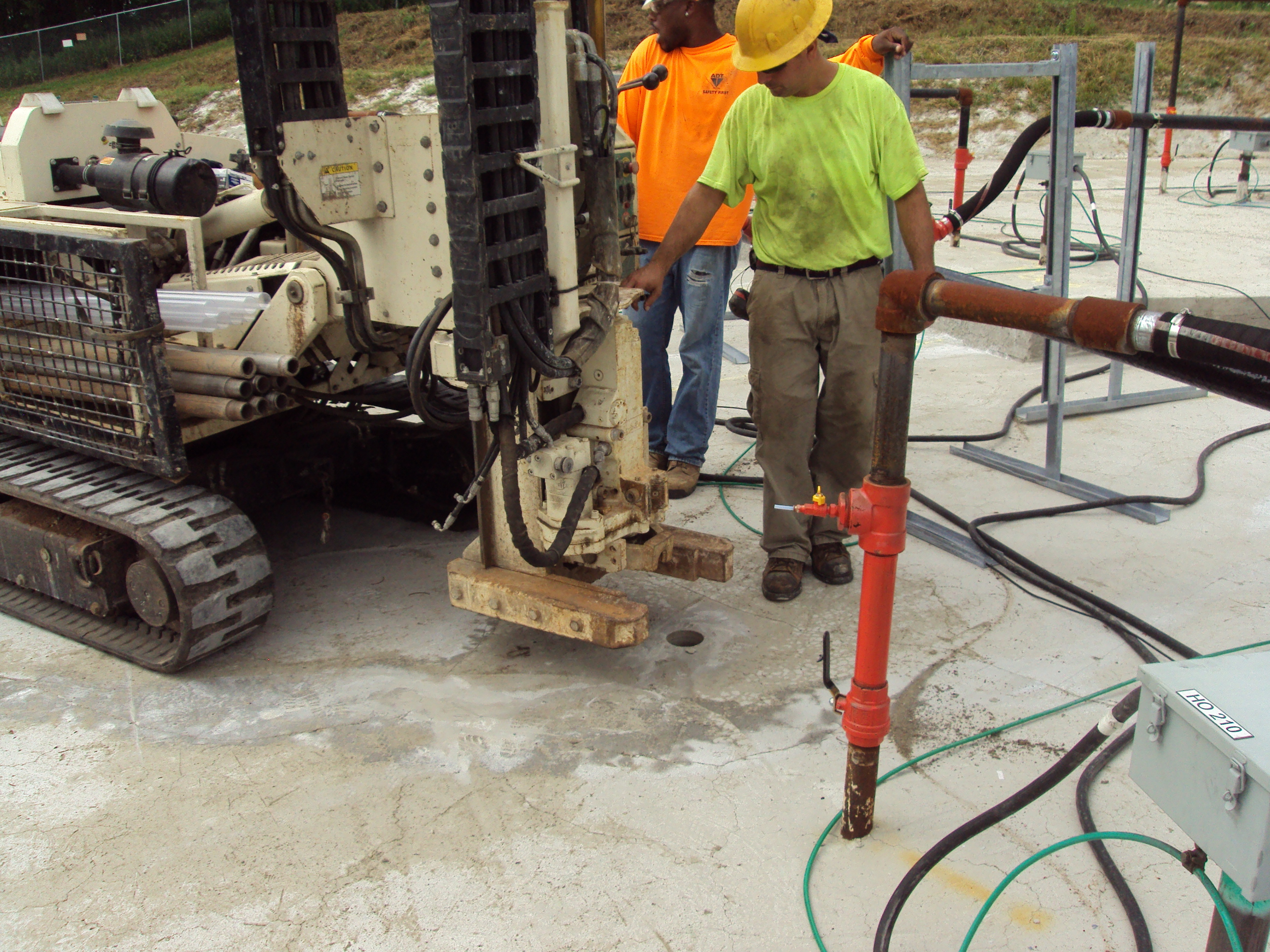

![Geoprobe drilling through the concrete cap for sampling.](https://www.srsnesite.com/wp-content/uploads/2014/09/20140728-DSC02849-drilling-through-the-concrete-cap--1024x768.jpg)
Geoprobe drilling through the concrete cap for sampling.

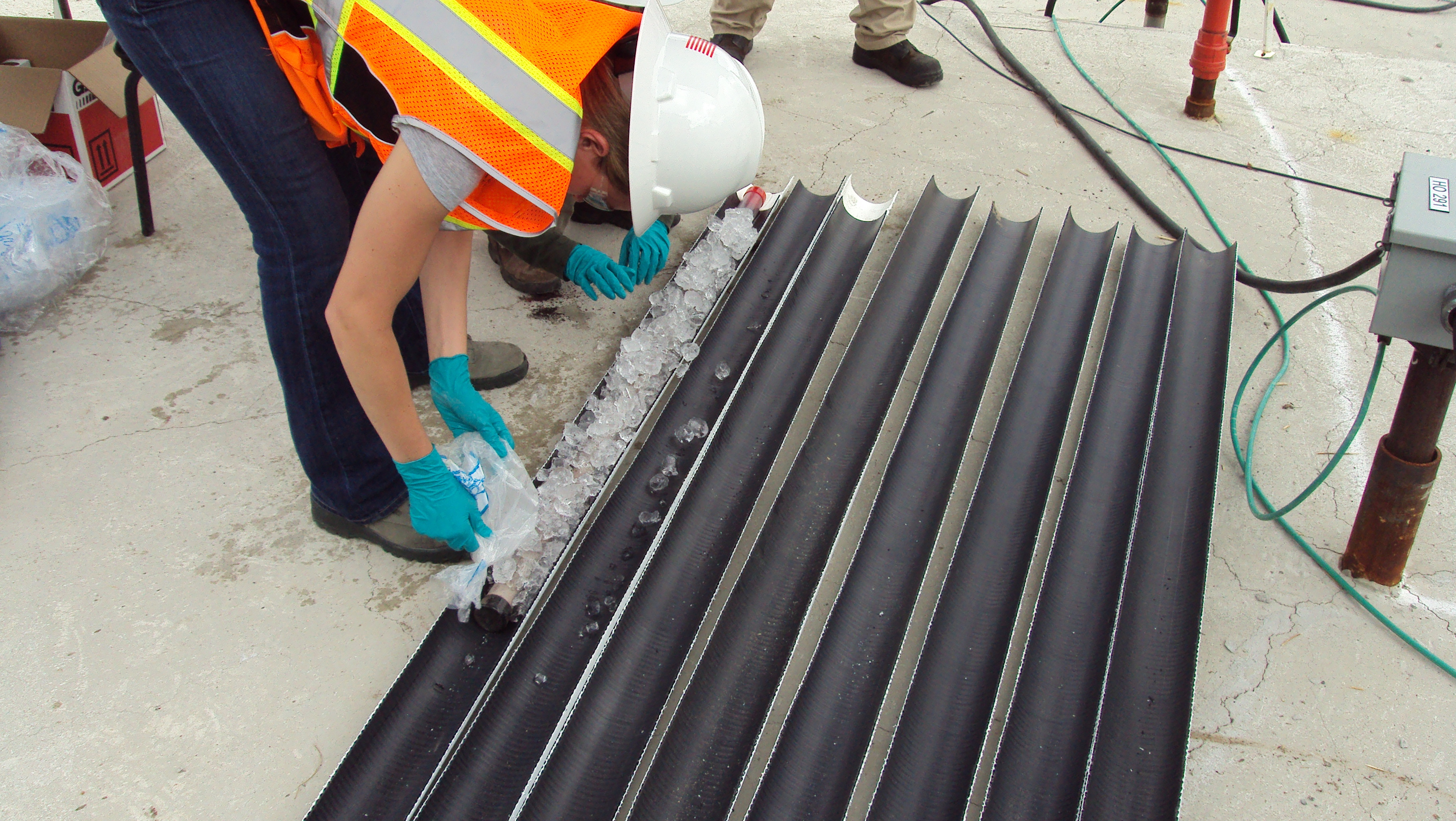

![20140728-DSC02850-cooling hot soil samples](https://www.srsnesite.com/wp-content/uploads/2014/09/20140728-DSC02850-cooling-hot-soil-samples-1024x577.jpg)
Cooling the hot soil samples for logging and containerizing for shipment to laboratory.
ISTR System Operations and Maintenance
Posted on June 17th, 2014

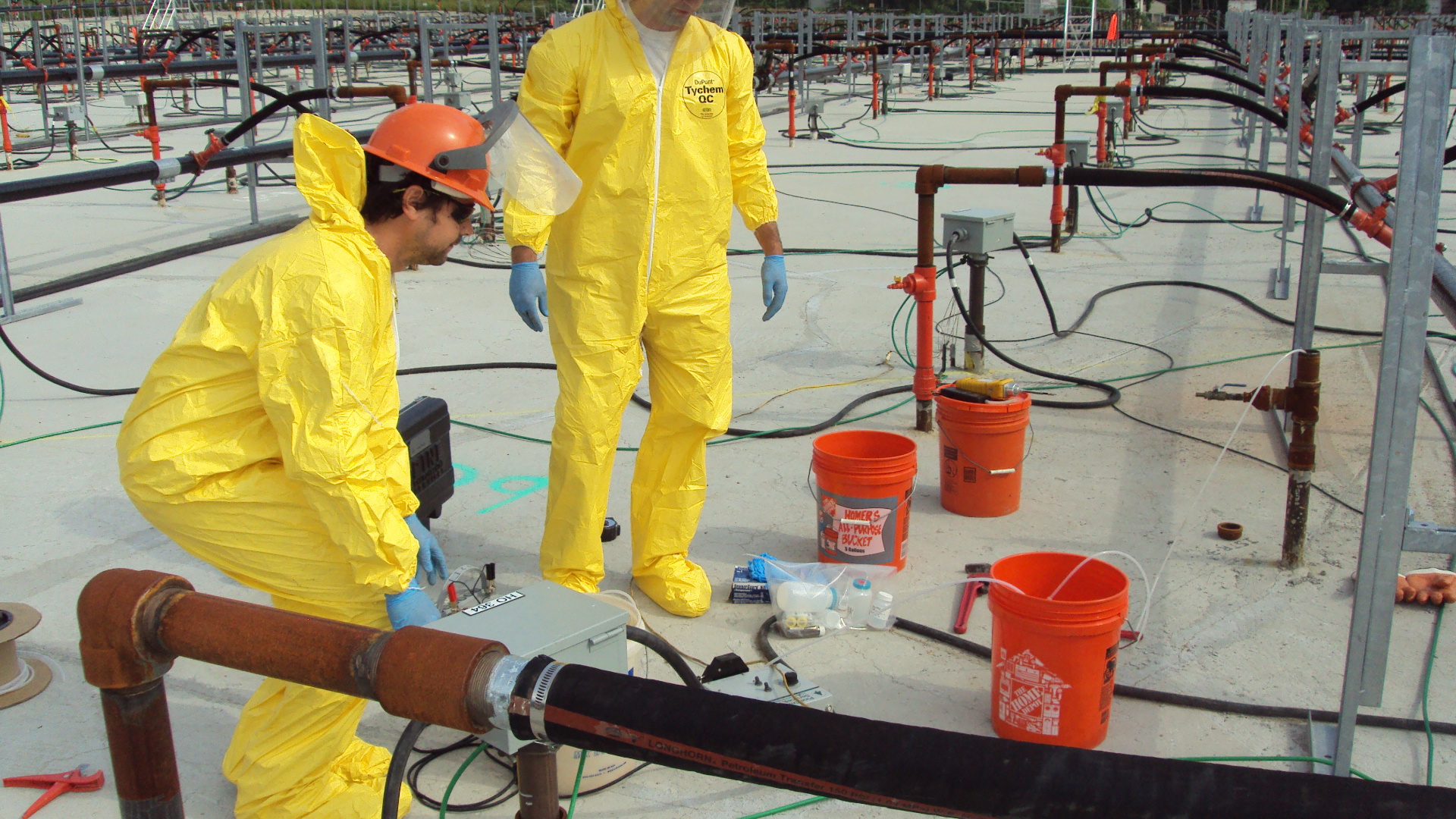

![Hot Groundwater Sampling 20140617-DSC02725-collecting hot gw samples](https://www.srsnesite.com/wp-content/uploads/2014/09/20140617-DSC02725-collecting-hot-gw-samples-1024x576.jpg)
Hot Groundwater Sampling

![20140612-DSC02718-maintenance of the wellfield](https://www.srsnesite.com/wp-content/uploads/2014/09/20140612-DSC02718-maintenance-of-the-wellfield-1024x682.jpg)
Maintenance of the well field on June 12th.

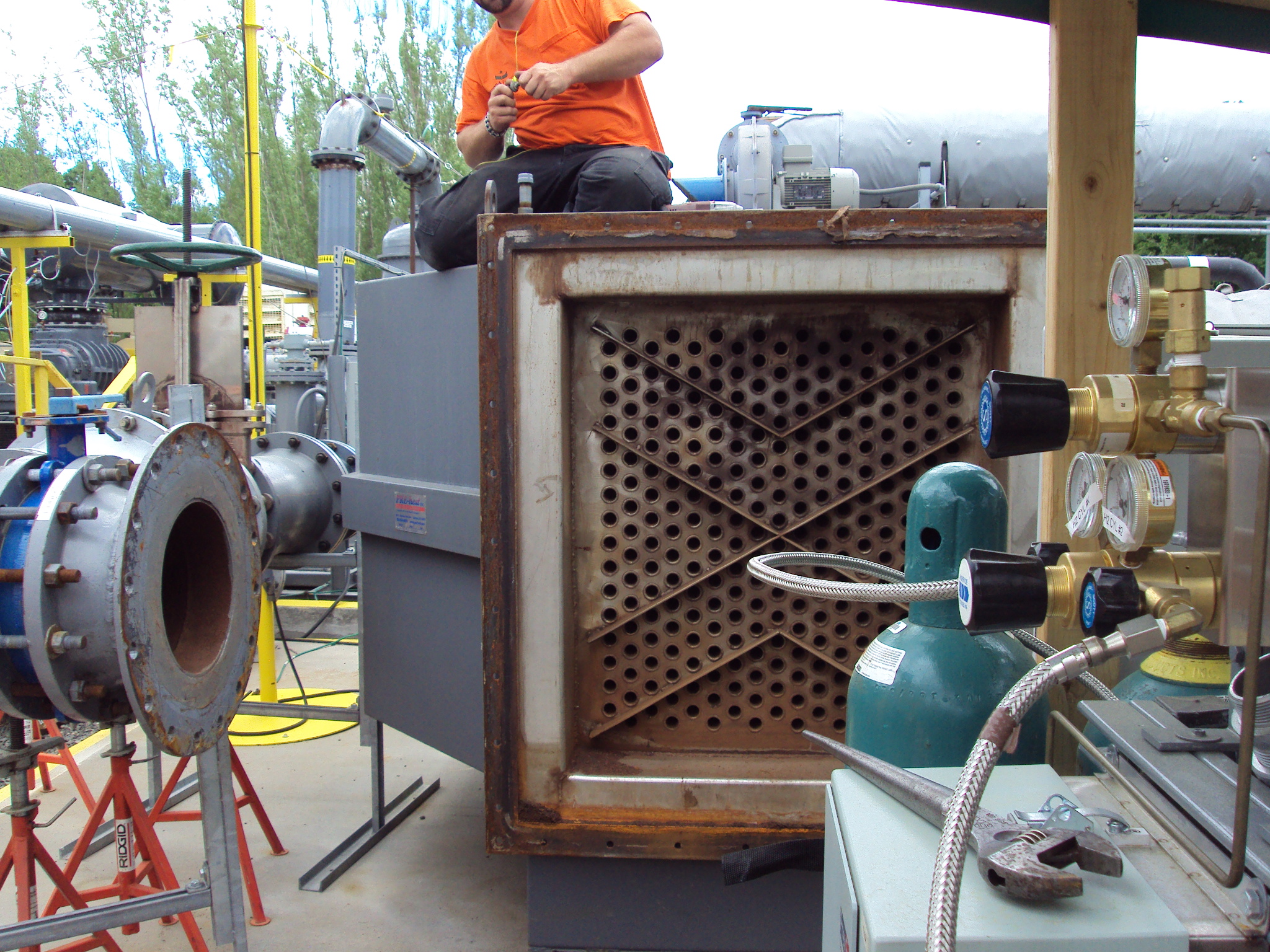

![Maintenance of the treatment system on June 6th 20140606-DSC02707-system maintenance](https://www.srsnesite.com/wp-content/uploads/2014/09/20140606-DSC02707-system-maintenance-1024x768.jpg)
Maintenance of the treatment system on June 6th
2014 Comprehensive Groundwater Sampling
Posted on June 14th, 2014

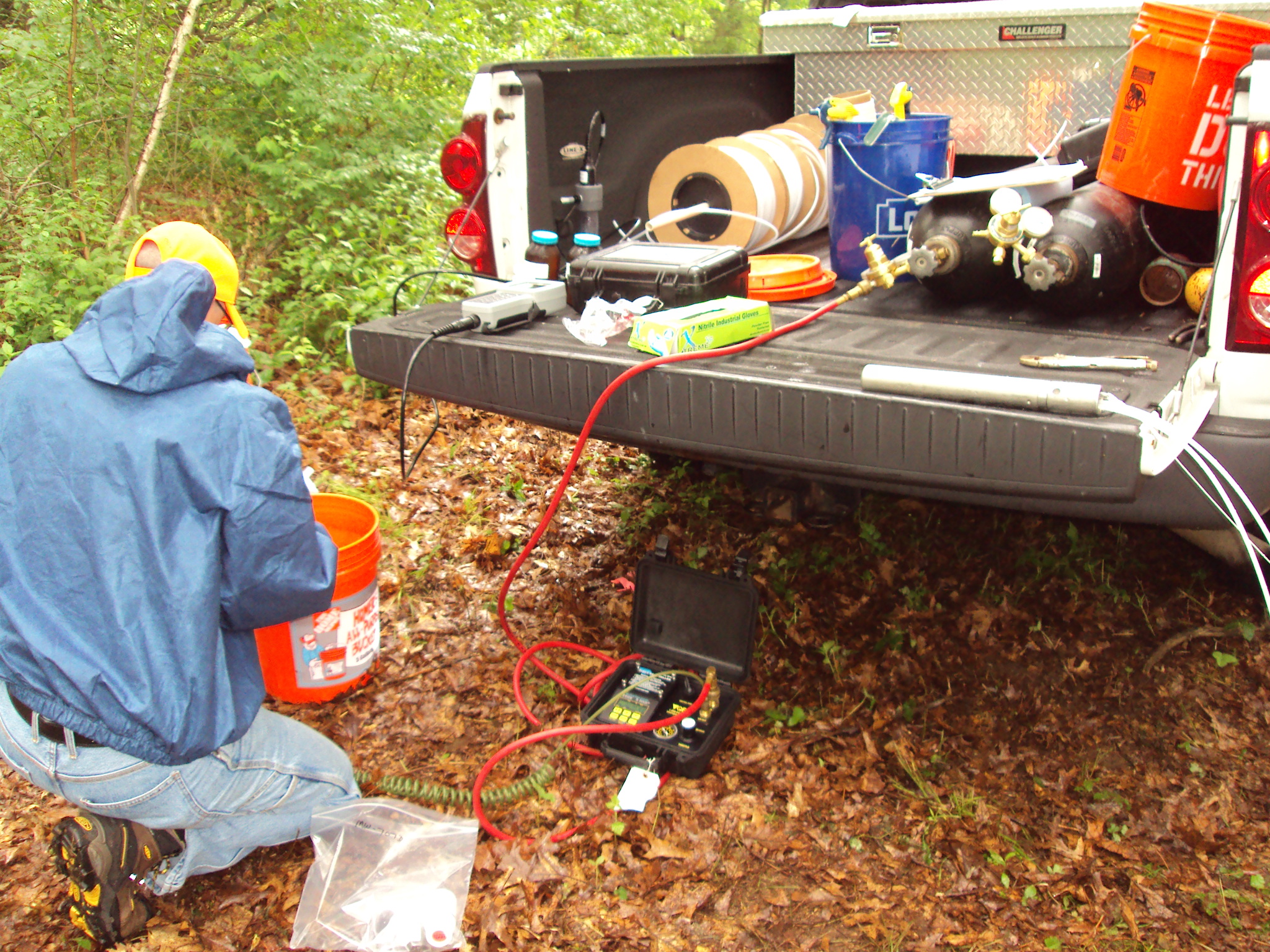

![20140610-DSC02710-annual GW sampling](https://www.srsnesite.com/wp-content/uploads/2014/09/20140610-DSC02710-annual-GW-sampling-1024x768.jpg)
2014 comprehensive groundwater sampling took place June 9th to June 13th, 2014.
In-Situ Thermal Remediation Begins
Posted on May 15th, 2014

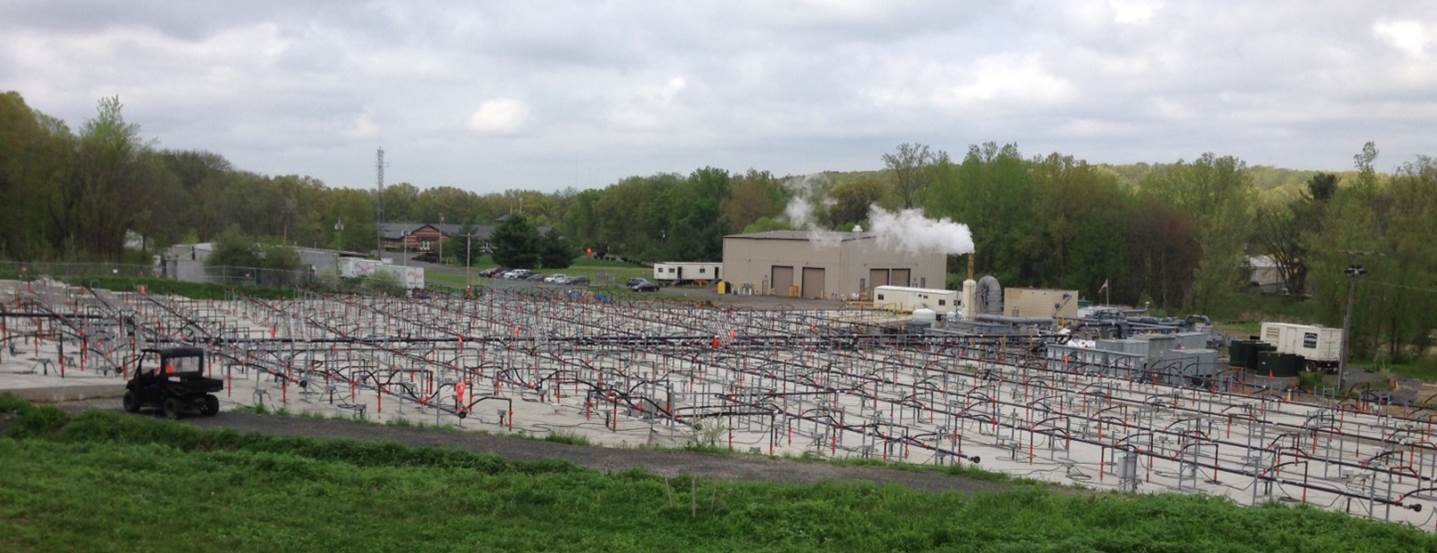

![In-Situ Thermal Remediation Begins on May 15, 2014](https://www.srsnesite.com/wp-content/uploads/2014/05/5-15-14_ISTR_begins-1024x394.jpg)
In-Situ Thermal Remediation Begins on May 15, 2014
Start-Up to Begin Soon
Posted on May 2nd, 2014

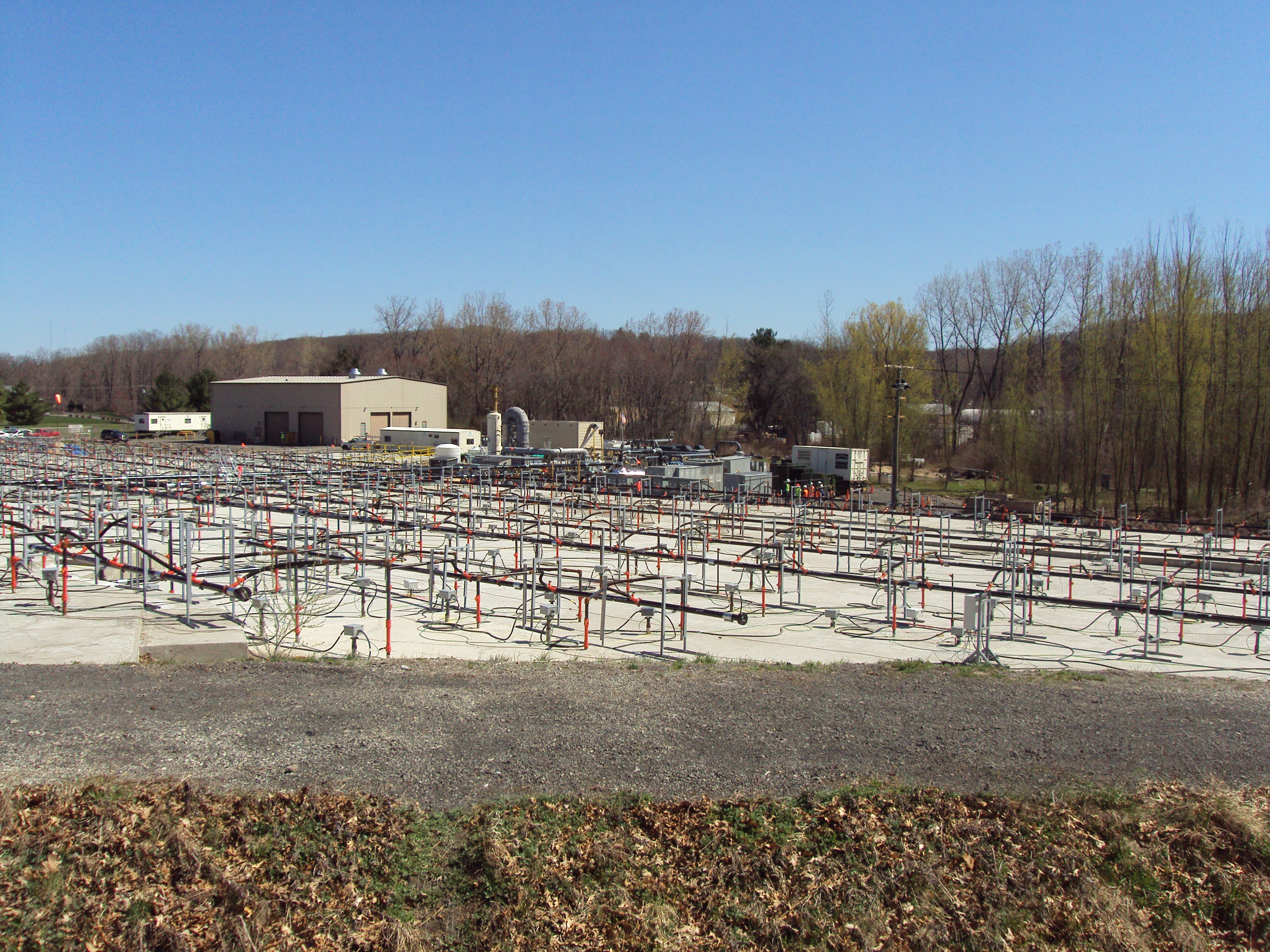

![Start-up soon!](https://www.srsnesite.com/wp-content/uploads/2014/05/04-24-14_startup_soon-1024x768.jpg)
Start-up soon!

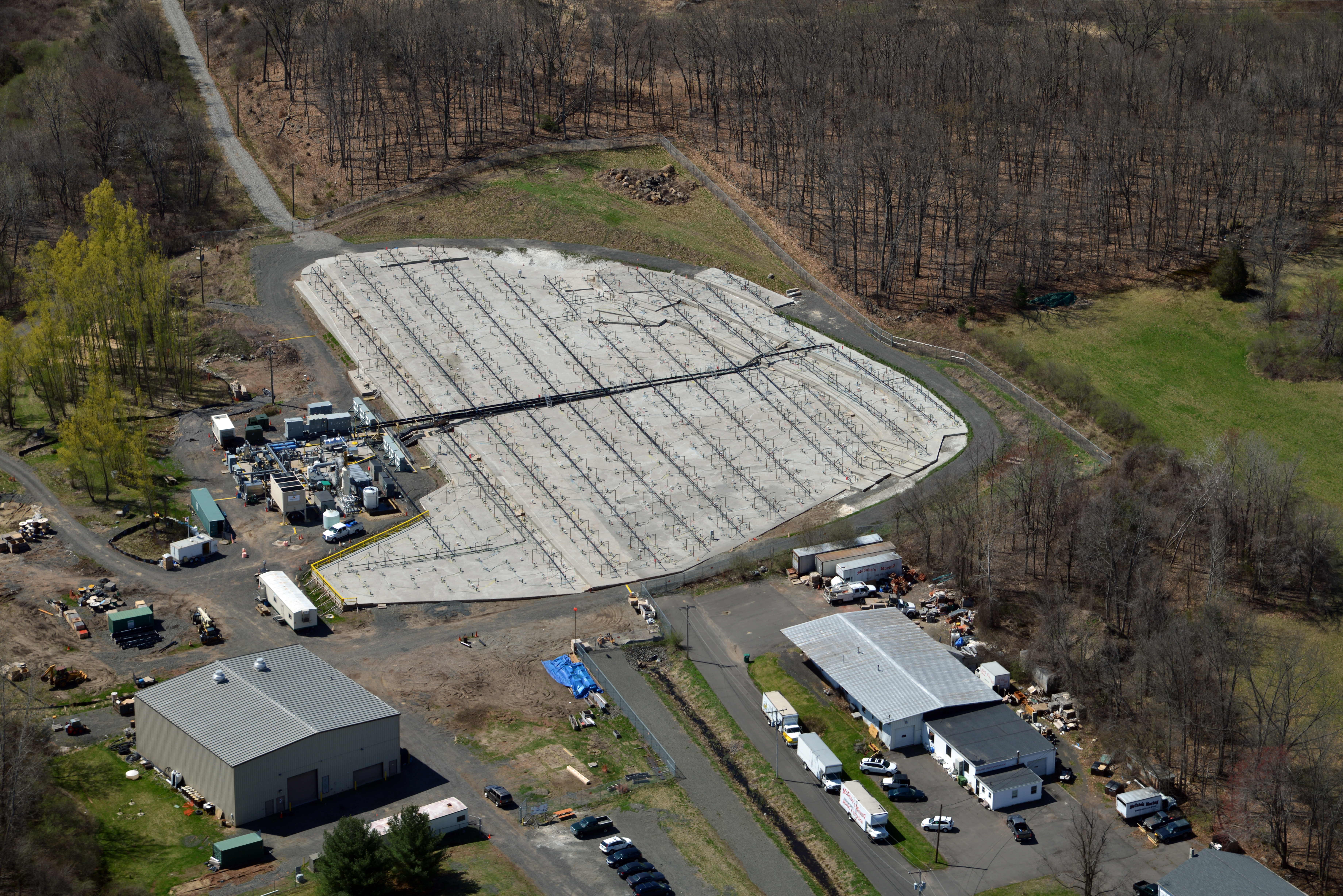

![Oblique Areial of ISTR from April 29, 2014](https://www.srsnesite.com/wp-content/uploads/2014/05/20140429_DSC_0205-1024x683.jpg)
Oblique Aerial of ISTR from April 29, 2014
February 2014 Photos
Posted on March 27th, 2014

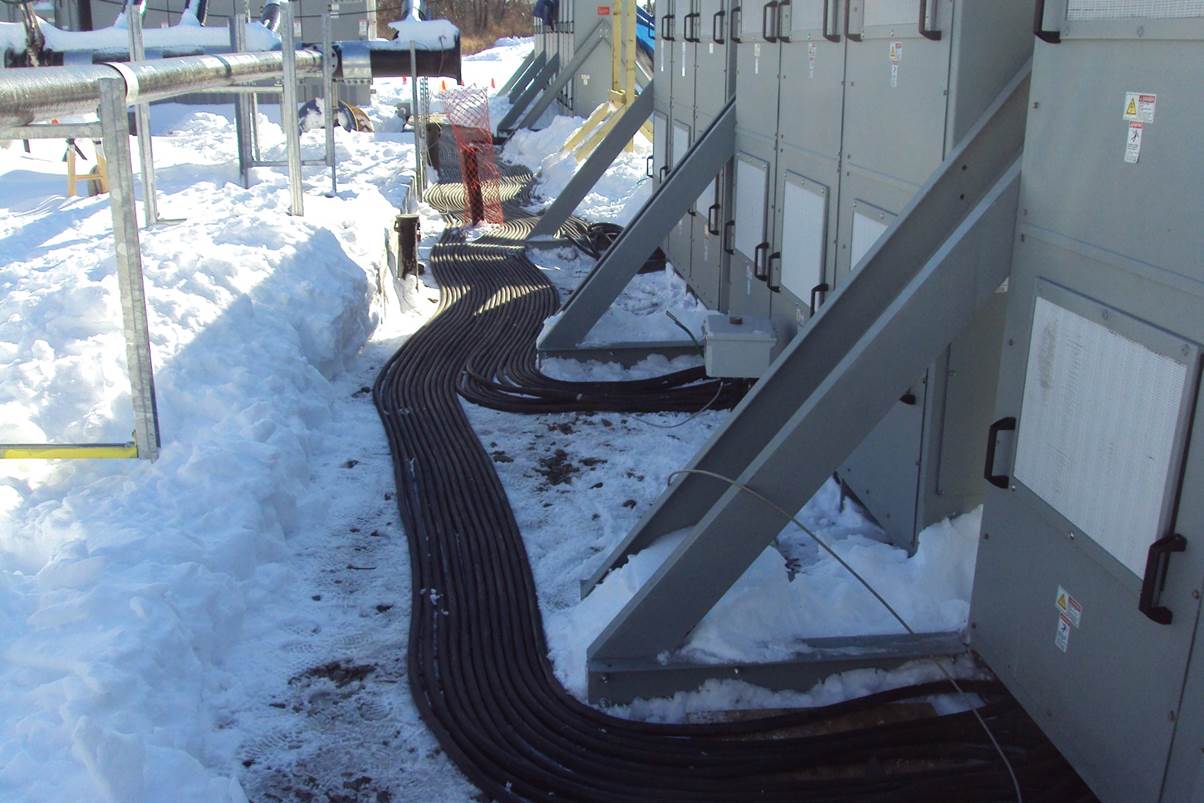

![Cabling connections to electrical power controllers on Feb 7, 2014](https://www.srsnesite.com/wp-content/uploads/2014/03/2-7-14_power_pwrpnt-1024x682.jpg)
Cabling connections to electrical power controllers on Feb 7, 2014

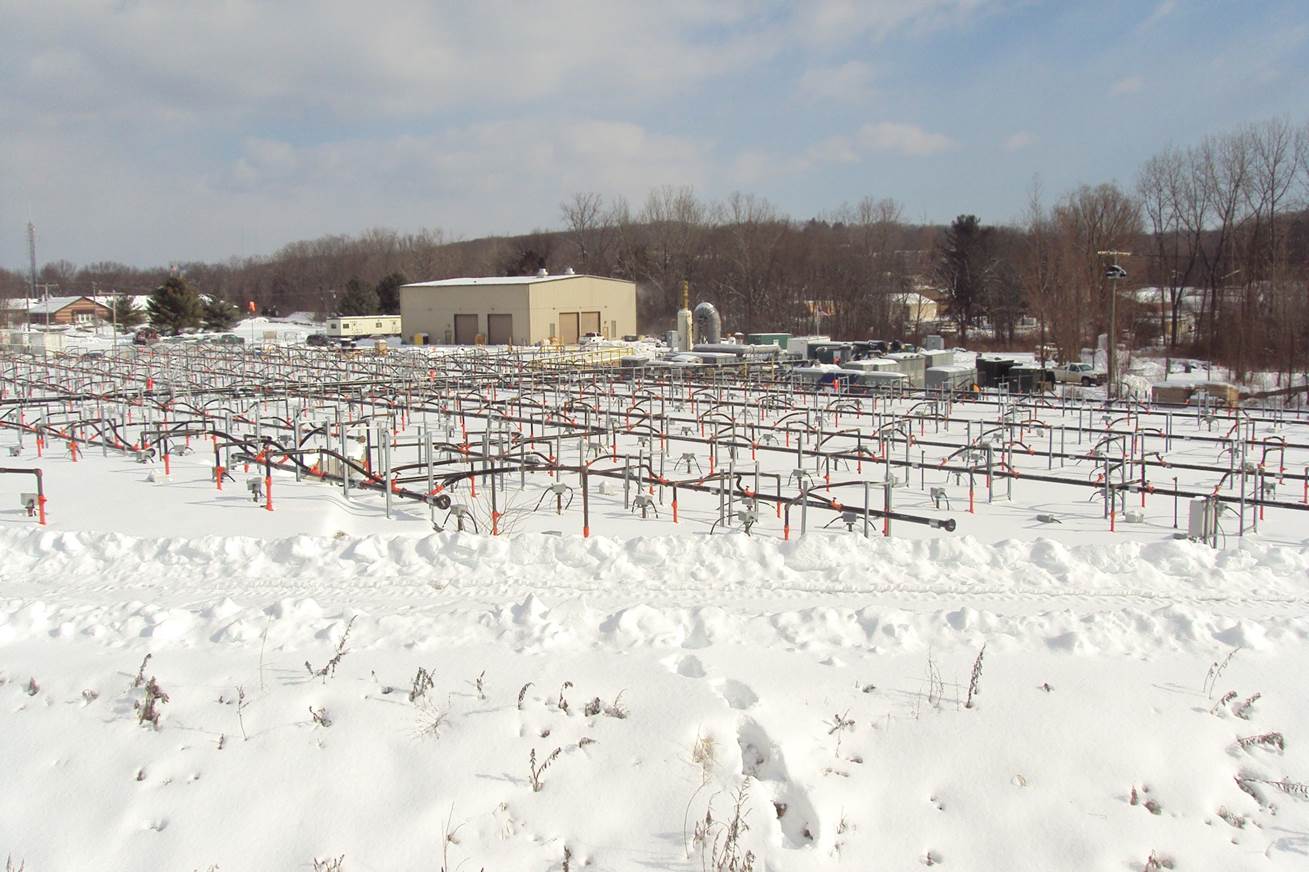

![A snow covered view from SW looking NE on Feb. 10, 2014](https://www.srsnesite.com/wp-content/uploads/2014/03/2-10-14_piping_pwrpnt-1024x682.jpg)
A snow covered view from SW looking NE on Feb. 10, 2014
Kicking off the New Year
Posted on January 31st, 2014

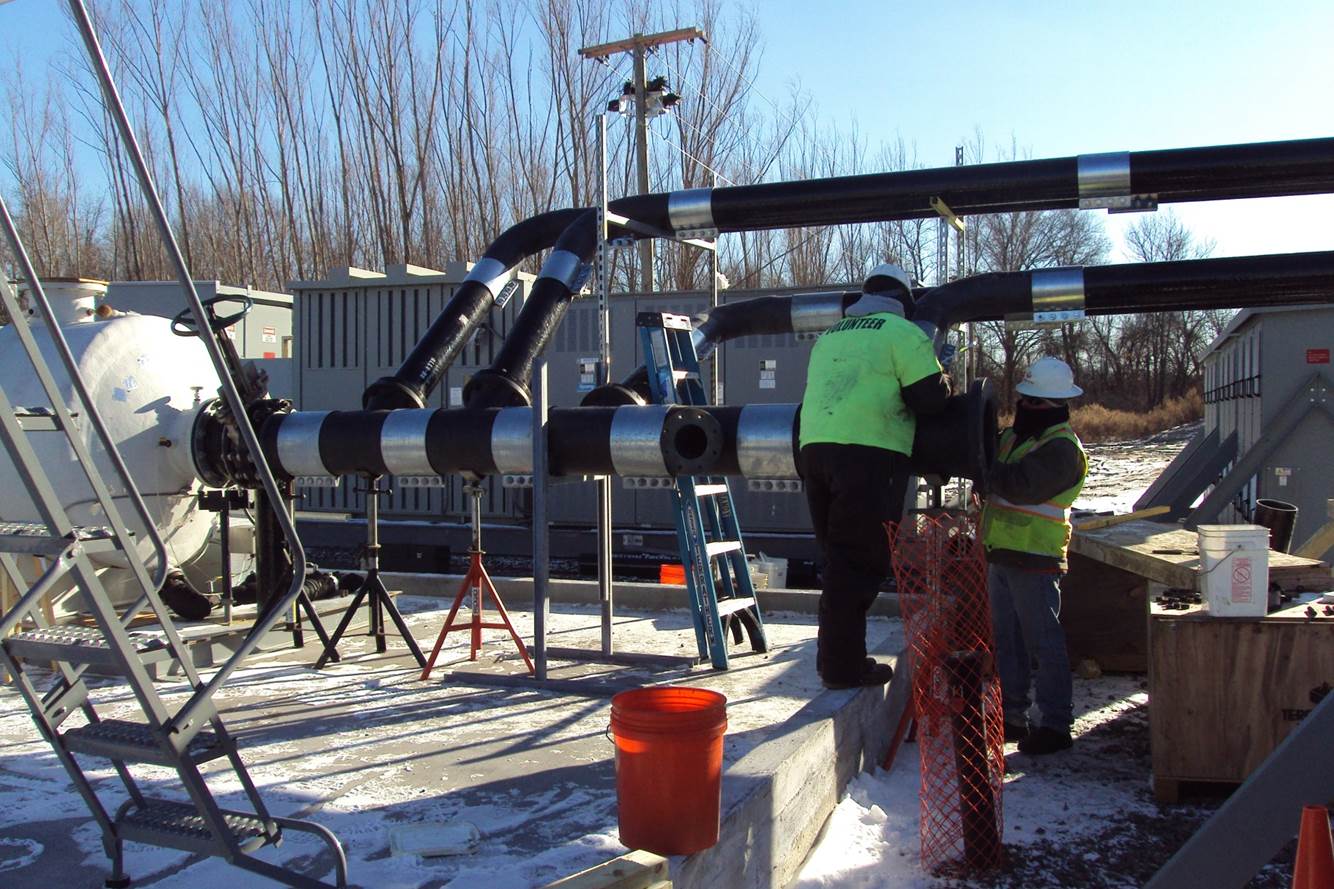

![Vapor Treatment System Construction on Jan. 7, 2014](https://www.srsnesite.com/wp-content/uploads/2014/03/1-7-14_vapor_treatment_pwrpnt-1024x682.jpg)
Vapor Treatment System Construction on Jan. 7, 2014

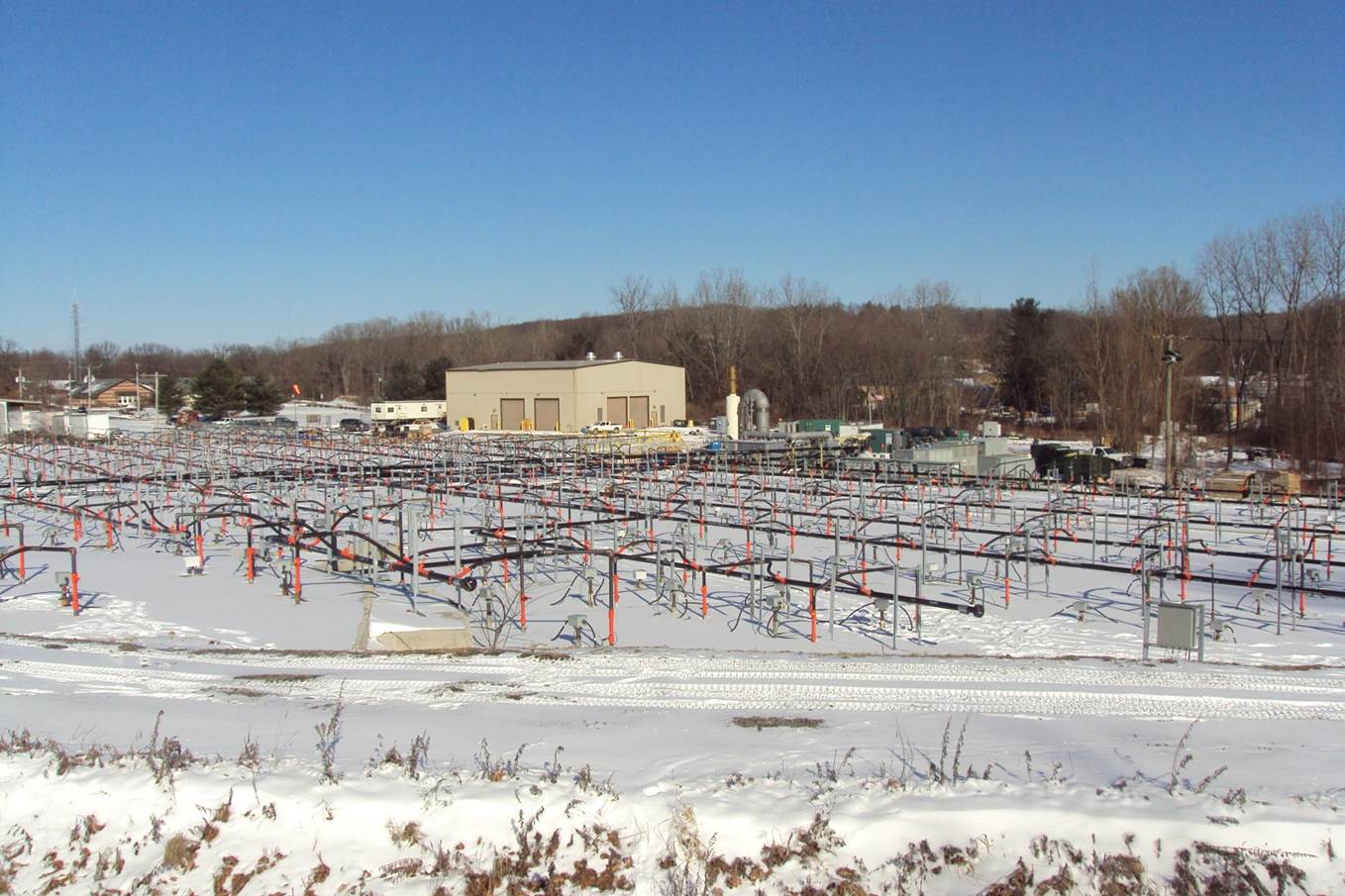

![Jan. 21, 2014](https://www.srsnesite.com/wp-content/uploads/2014/03/1-21-14_pwrpnt-1024x682.jpg)
Jan. 21, 2014
December 2013
Posted on January 1st, 2014

![Monitoring Well (#4 or 7)](https://www.srsnesite.com/wp-content/uploads/2014/03/12-4-13_well_pwrpnt-1024x682.jpg)
Monitoring Well (#4 of 7)

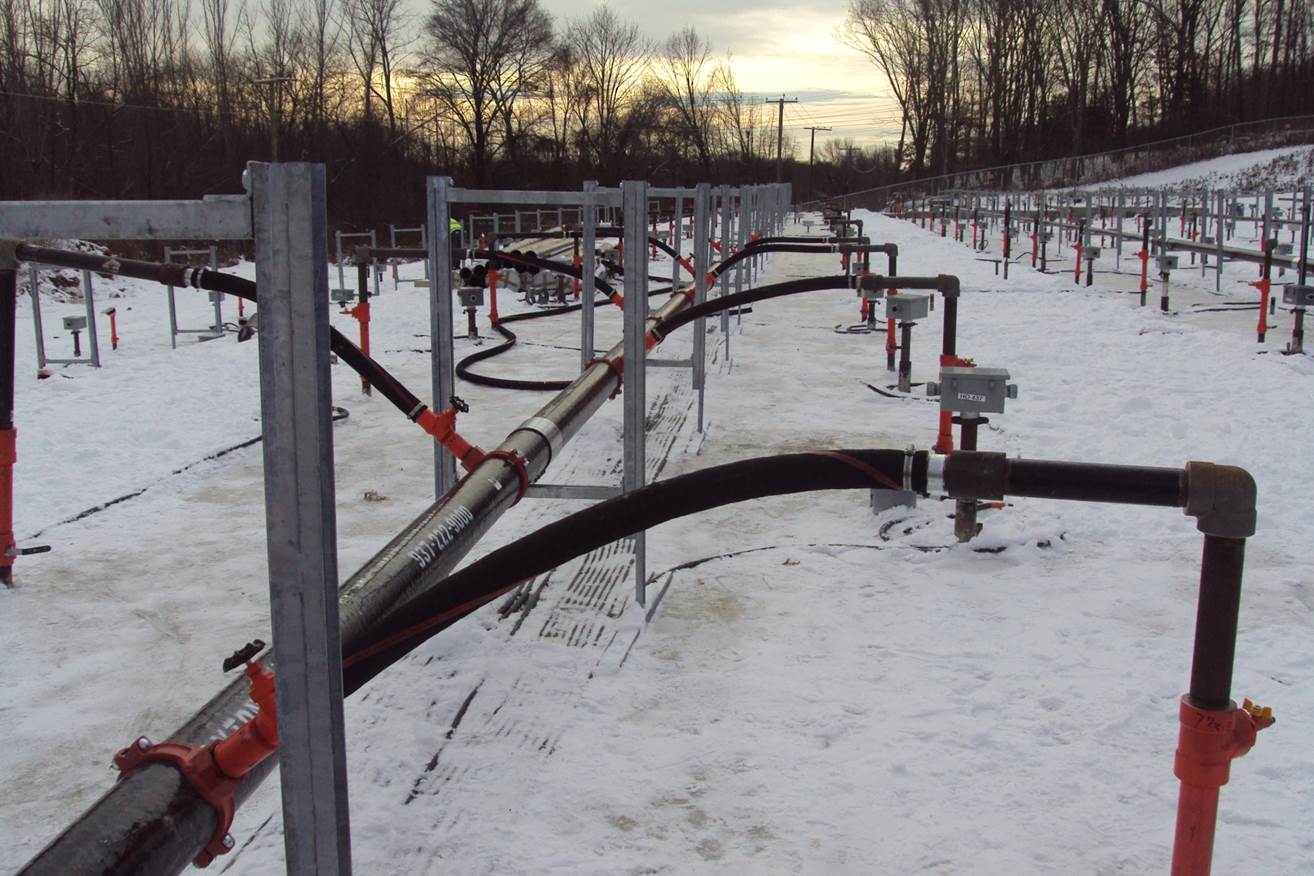

![Vapor monitoring wells on Dec. 13, 2013](https://www.srsnesite.com/wp-content/uploads/2014/03/12-13-13_vapor_wells_pwrpnt-1024x682.jpg)
- Vapor extraction wells on Dec. 13, 2013

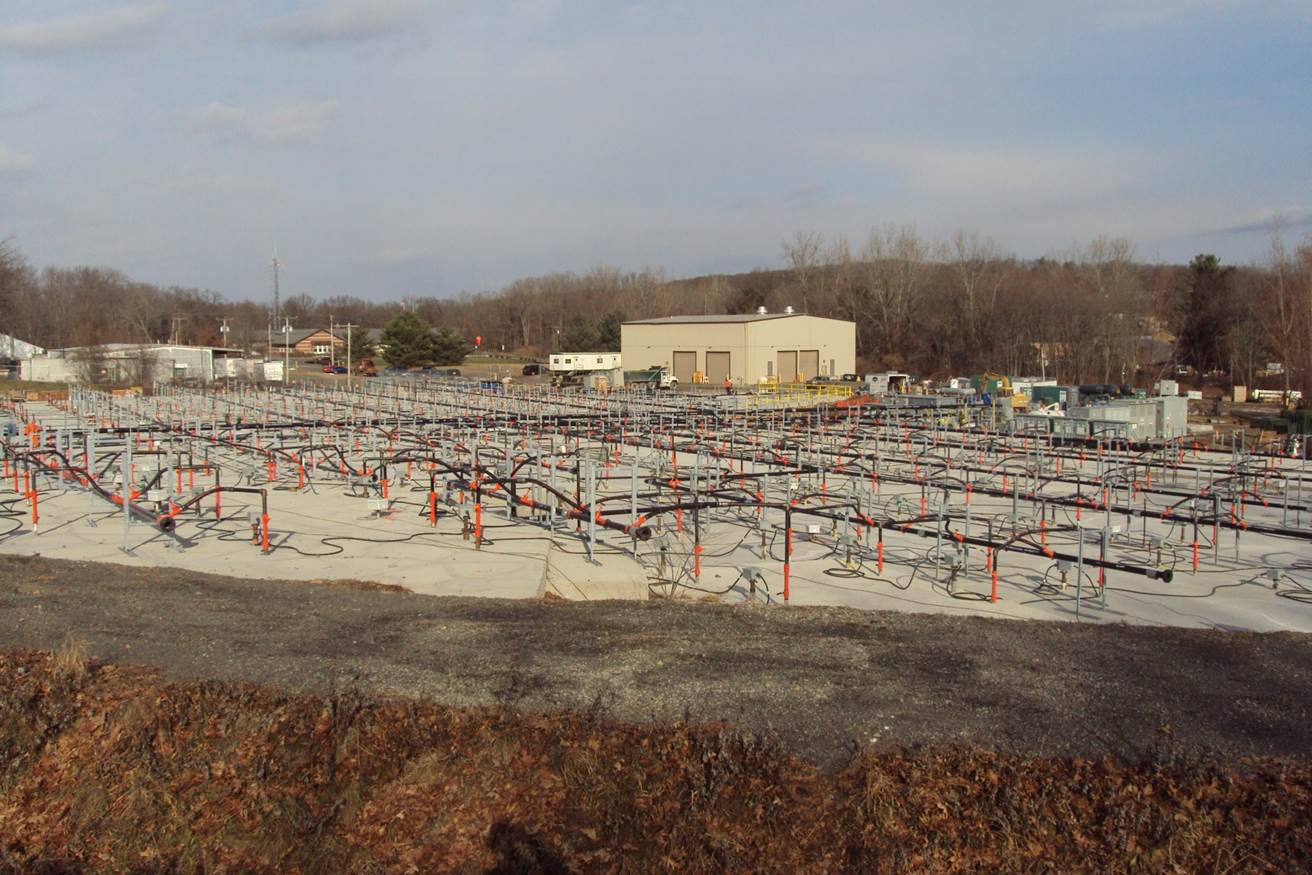

![View from SW on Dec. 31, 2013.](https://www.srsnesite.com/wp-content/uploads/2014/03/12-31-13-1024x682.jpg)
Piping and cabling installation. View from SW on Dec. 31, 2013.
November Photos
Posted on December 1st, 2013

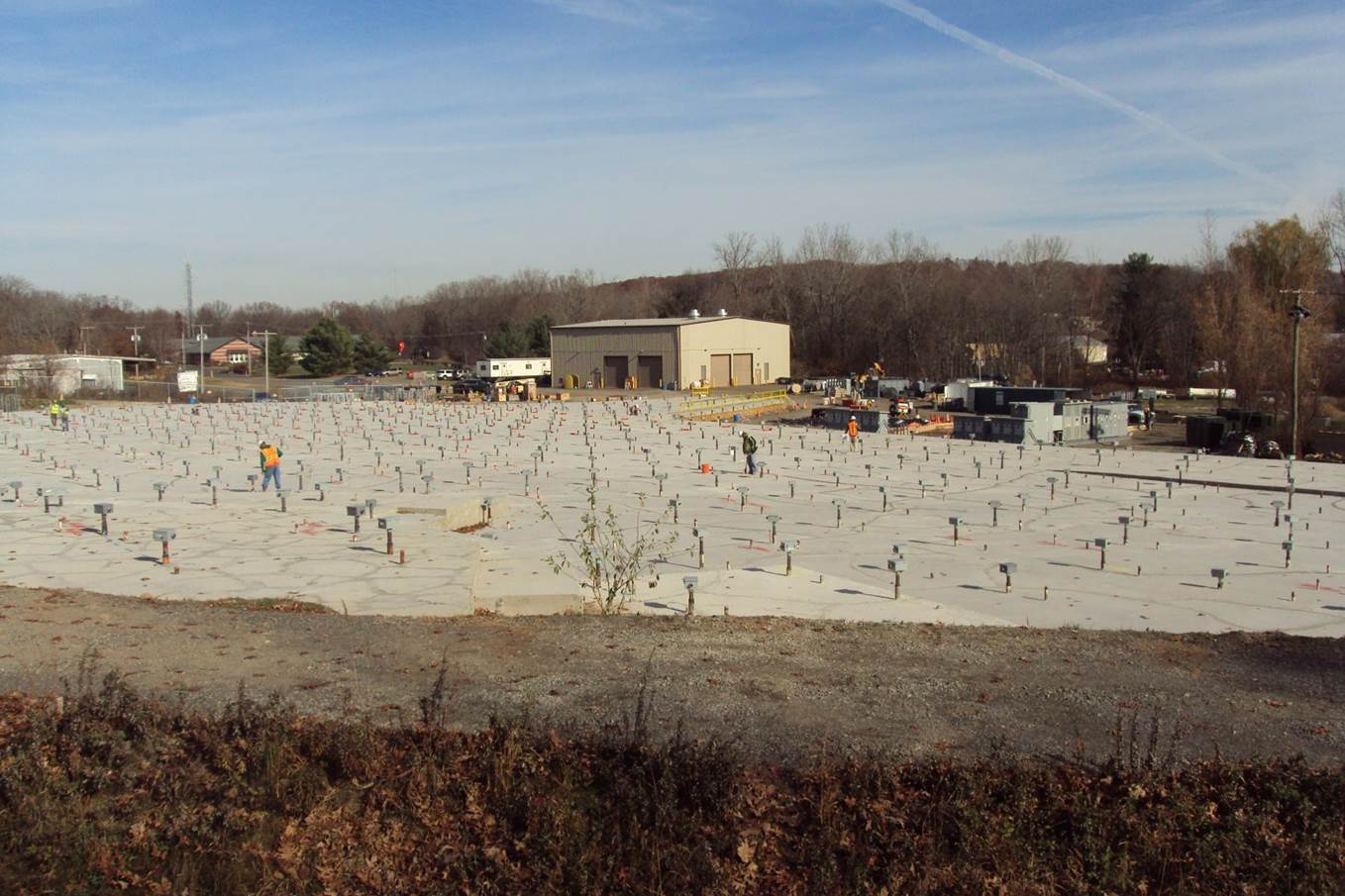

![View from SW looking toward NE on Nov. 15, 2013.](https://www.srsnesite.com/wp-content/uploads/2014/03/11-15-13_pwrpnt-1024x682.jpg)
View from SW looking toward NE on Nov. 15, 2013.

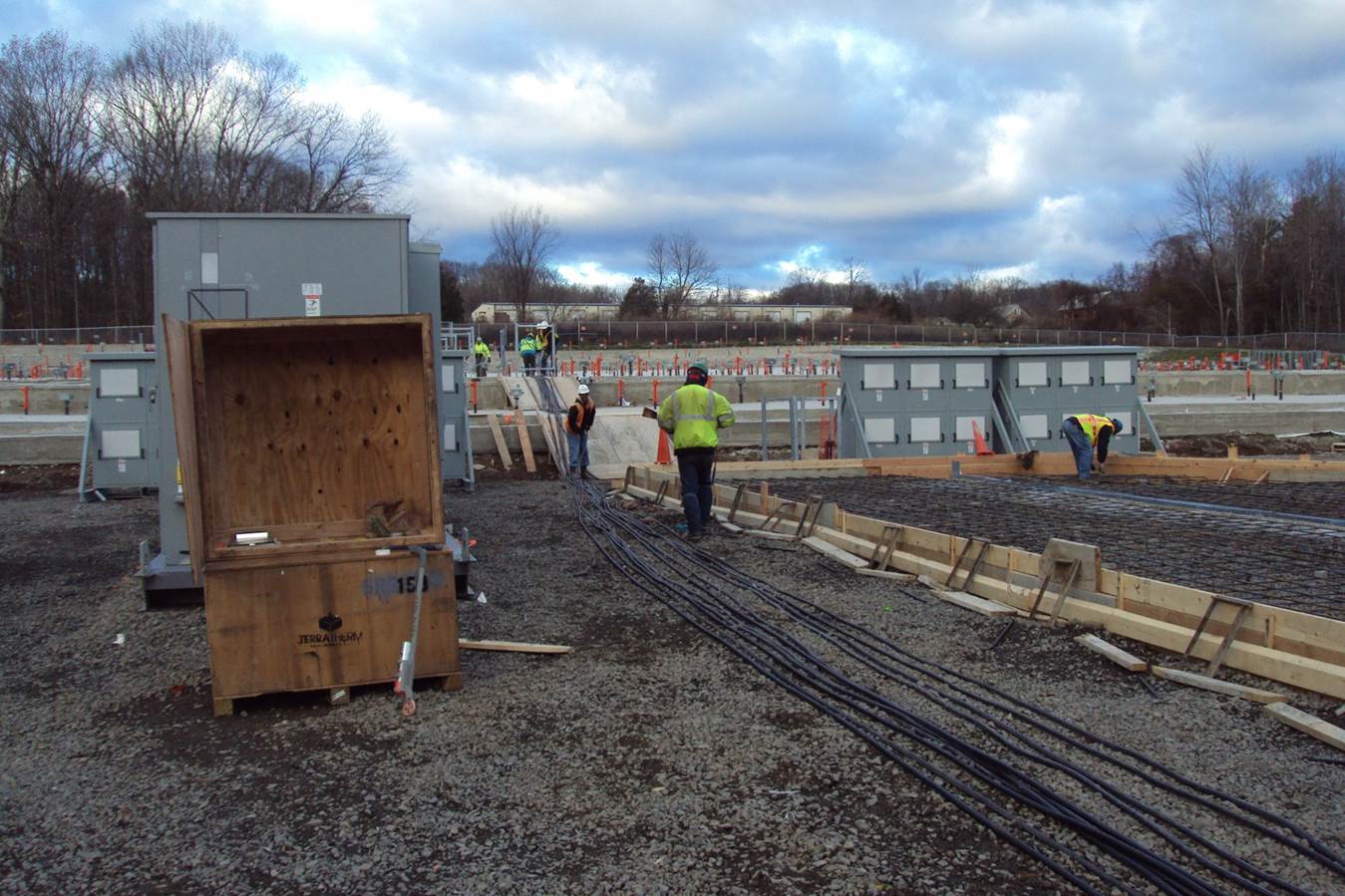

![Start of cabling to well heads Nov. 19, 2013.](https://www.srsnesite.com/wp-content/uploads/2014/03/11-19-13_cabling_pwrpnt-1024x682.jpg)
Start of cabling to well heads Nov. 19, 2013.
Cap Installation Oct-Nov, 2013
Posted on November 15th, 2013
![Start of cap installation on Oct. 1, 2013.](https://www.srsnesite.com/wp-content/uploads/2014/03/10-1-13_cap_install_pwrpnt.jpg)
Start of cap installation on Oct. 1, 2013.
![Cap installation Oct. 14, 2013](https://www.srsnesite.com/wp-content/uploads/2014/03/10-14-13_cap_intall_pwrpnt.jpg)
Cap installation Oct. 14, 2013
![Applying sealant to cap on Nov. 4, 2013](https://www.srsnesite.com/wp-content/uploads/2014/03/11-4-13_sealant_to_cap_pwrpnt.jpg)
Applying sealant to cap on Nov. 4, 2013
![Well field completed - Nov. 12, 2013](https://www.srsnesite.com/wp-content/uploads/2014/03/11-12-13_well_field_complete.jpg)
Well field completed – Nov. 12, 2013
Open House 2013
Posted on September 7th, 2013
![de maximis Project Coordinator discussing the site remediation progress with a group from UCONN and Middlesex Community College](https://www.srsnesite.com/wp-content/uploads/2013/09/Open-House-2013-image2-1024x768.jpeg)
de maximis Project Coordinator discussing the site remediation progress with a group of students from UCONN and Middlesex Community College.
Many topics were discussed, such as thermal treatment, groundwater monitoring, and future work. For more details see the Documents and Links Page for “Open House 2013” Posters and Briefing Book.
Bedrock Core

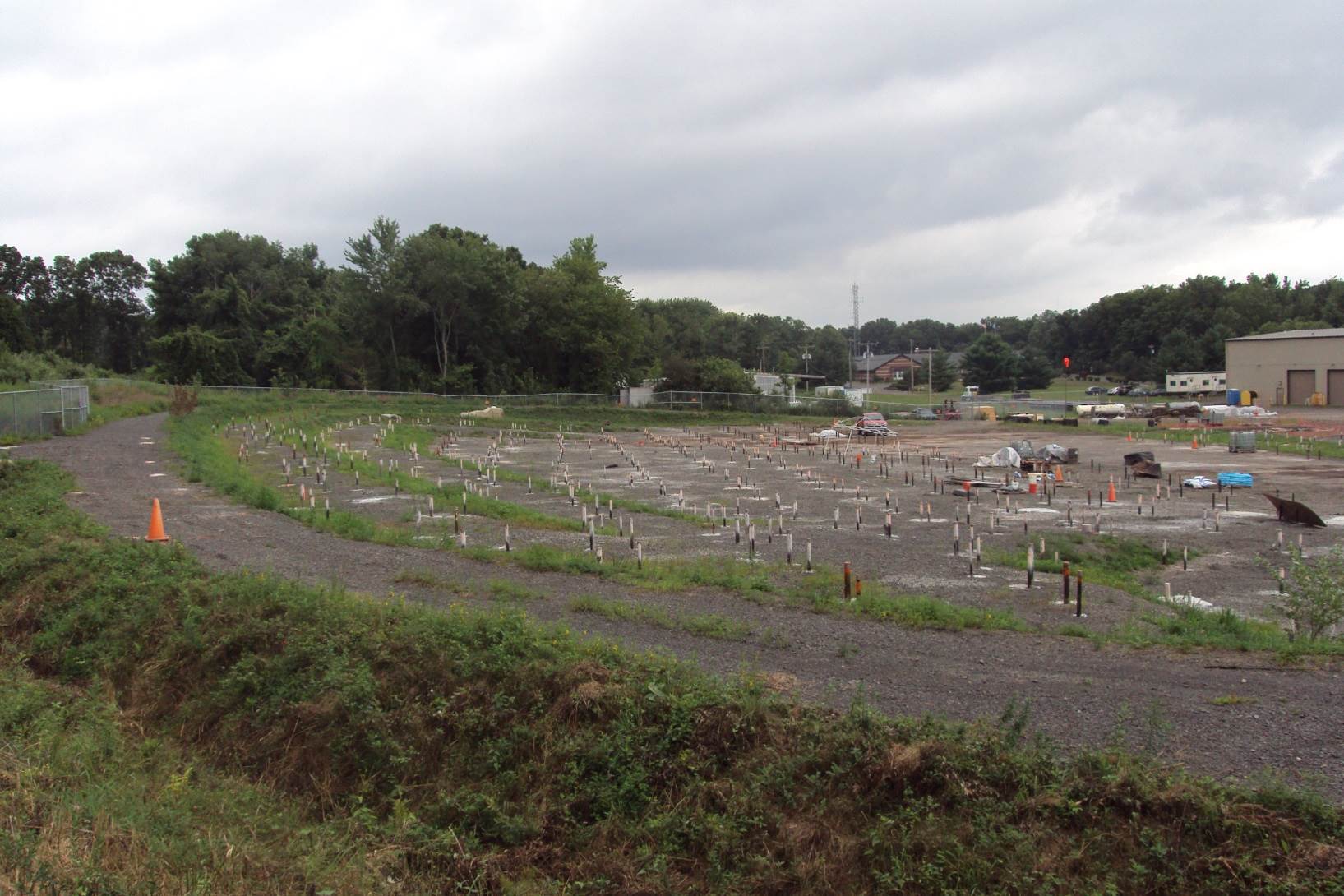

Posted on August 8th, 2013

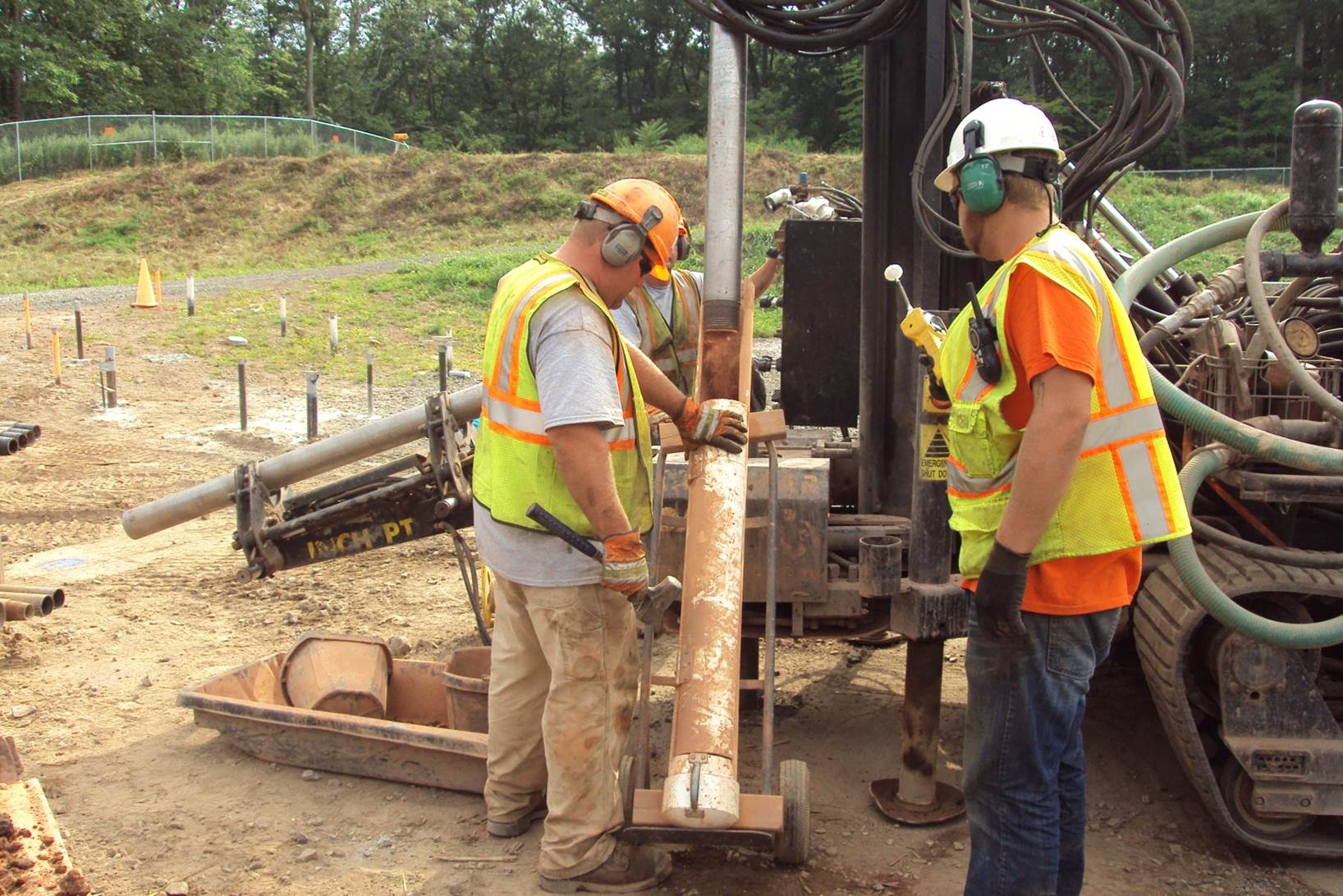

![8-8-13_bedrock core](https://www.srsnesite.com/wp-content/uploads/2013/08/8-8-13_bedrock-core_pwrpnt-1024x683.jpg)
John (Cascade Drilling) and Garrett (TerraTherm) prepare a core for determining bedrock.
![8-8-13](https://www.srsnesite.com/wp-content/uploads/2013/08/8-8-13_pwrpnt-1024x682.jpg)
Installed to date:
HO-440 (74%)
VEW-428 (78%)
TMP-60 (62%)
PMP-42 (66%)
ISTR- 3 (43%)
Drilling Status Update
Posted on August 6th, 2013

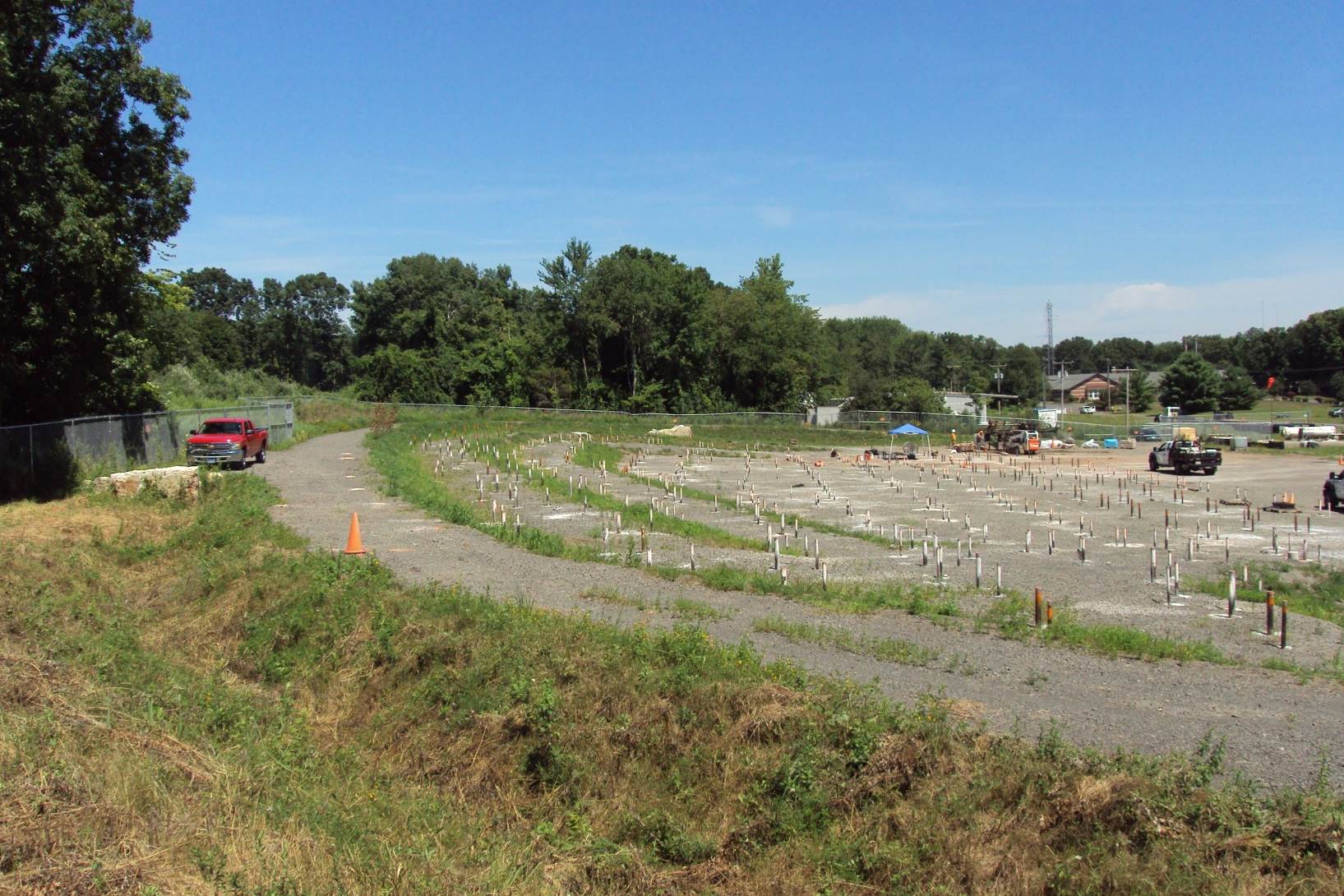

![8-6-13](https://www.srsnesite.com/wp-content/uploads/2013/08/8-6-13_pwrpnt-1024x682.jpg)
Installed to date:
430 (73%) Heater Wells (HO)
419 (76%) Vapor Extraction Wells (VEW)
57 (59%) Temperature Monitoring Points (TMP)
PMP- 40 (63%) Pressure Monitoring Points (PMP)
2 (29%) In-situ Thermal Remediation (ISTR)
Site Photo July 30,2013
Posted on July 30th, 2013

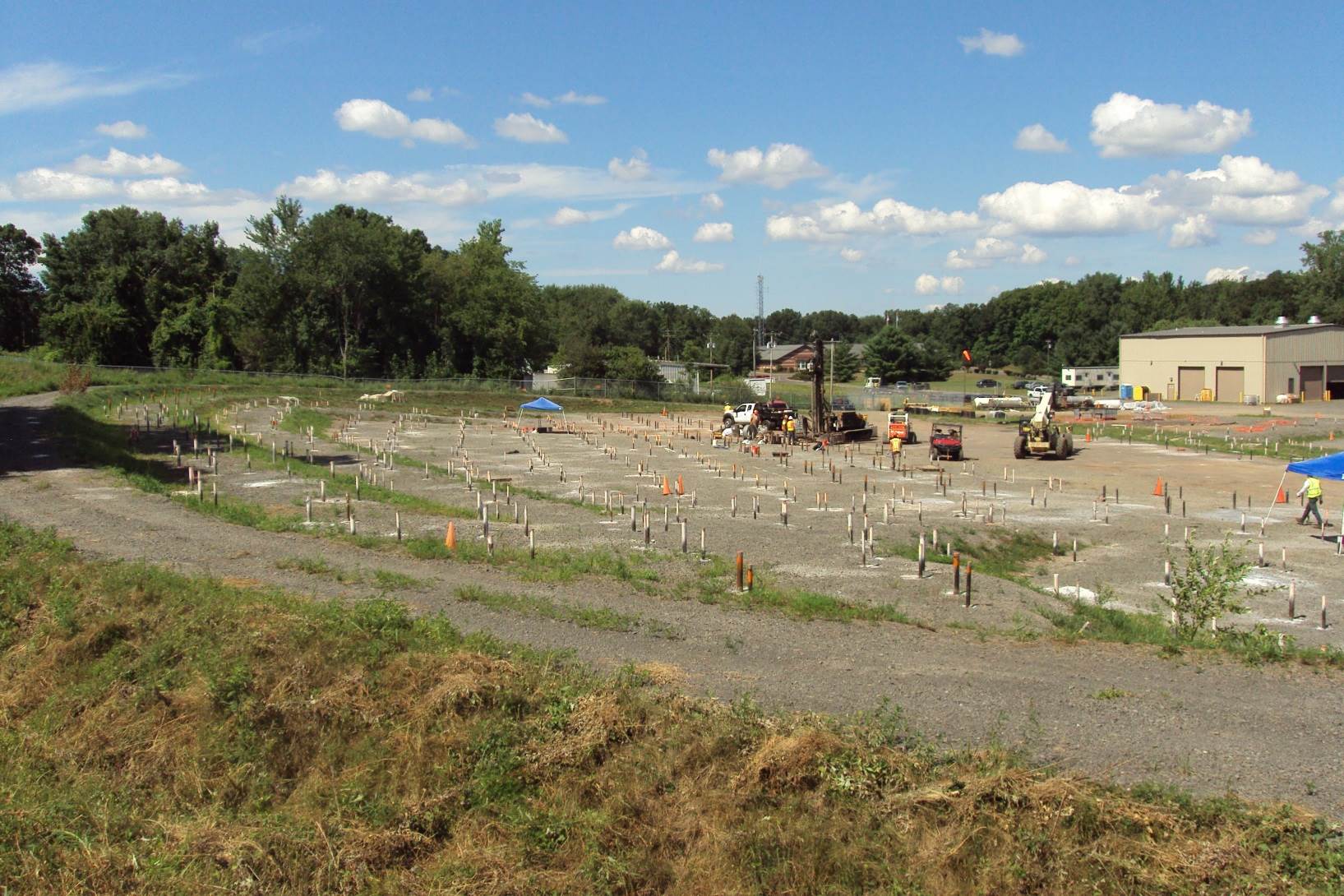

![7-30-13](https://www.srsnesite.com/wp-content/uploads/2013/08/7-30-13_pwrpnt-300x200.jpg)
Installed to date:
415 (70%) Heater Wells (HO)
403 (73%) Vapor Extraction Wells (VEW)
54 (56%) Temperature Monitoring Points (TMP)
38 (59%) Pressure Monitoring Points (PMP)
2 (29%) In-situ Thermal Remediation (ISTR)
Status Update
Posted on June 27th, 2013

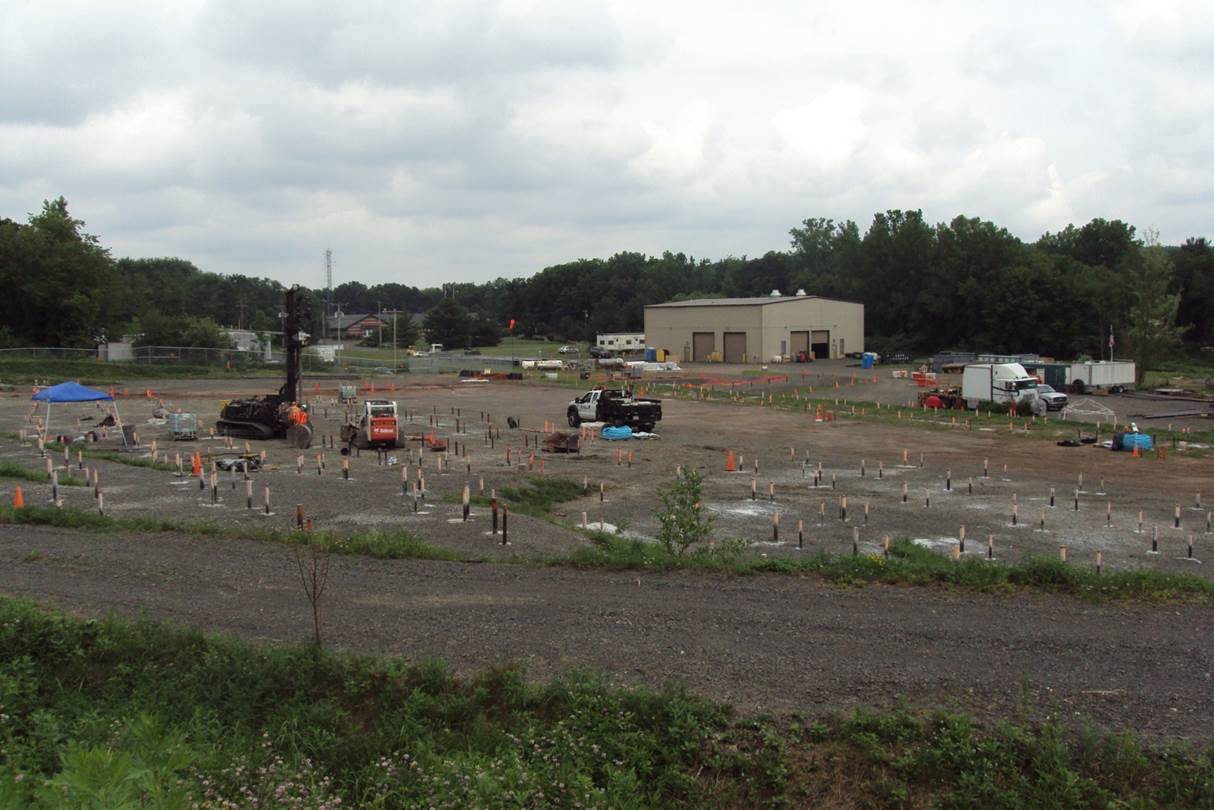

![6-27-13_pwrpnt](https://www.srsnesite.com/wp-content/uploads/2013/08/6-27-13_pwrpnt-300x200.jpg)
Installed to date: 321 (54%)Heater Wells (HO), 312 (57%) Vapor Extraction Wells (VEW), 40 (41%) Temperature Monitoring Points (TMP), and 28 (44%) Pressure Monitoring Points (PMP).
Status Update of ISTR Well Installation
Posted on June 20th, 2013

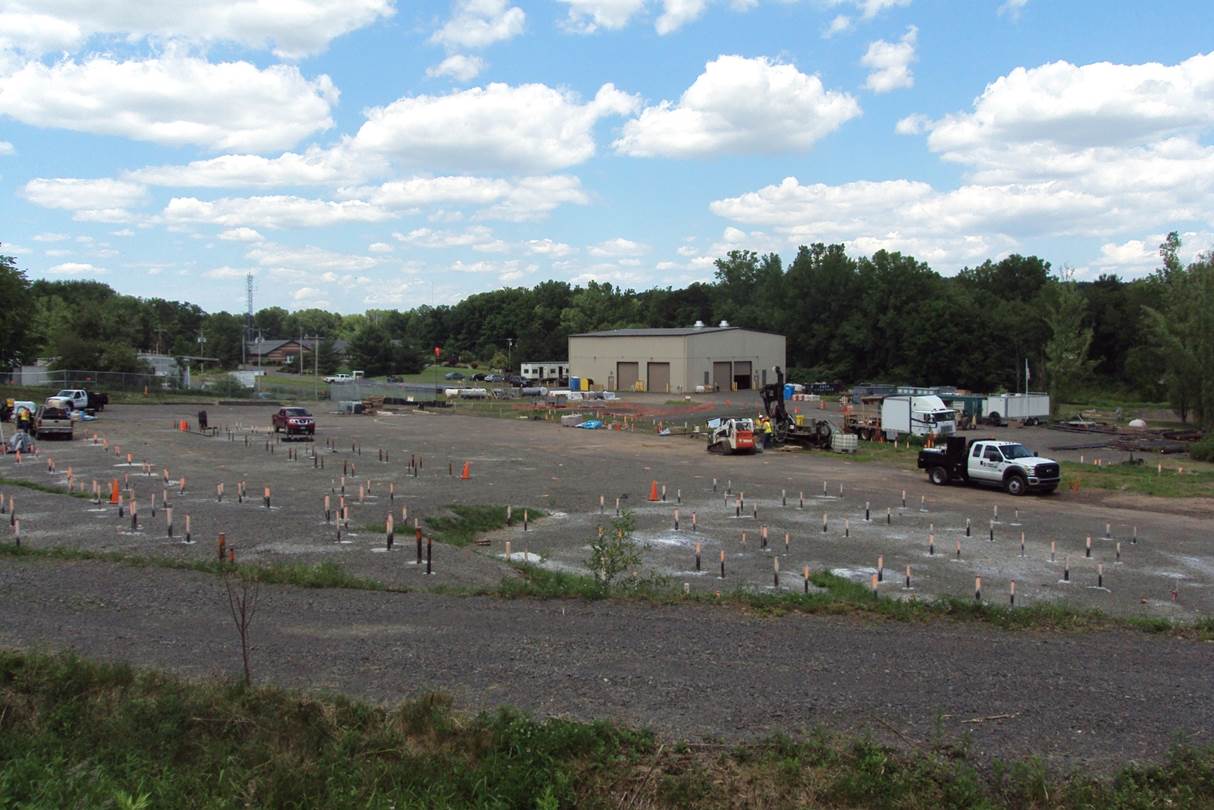

![6-20-13_pwrpnt](https://www.srsnesite.com/wp-content/uploads/2013/08/6-20-13_pwrpnt-300x200.jpg)
Installed to date: 283 (48%) Heater Wells (HO), 280 (51%) Vapor Extraction Wells (VEW), 31 (32%) Temperature Monitoring Points (TMP), and 24 (38%) Pressure Monitoring Points (PMP).
Drilling Progress Continues at SRSNE

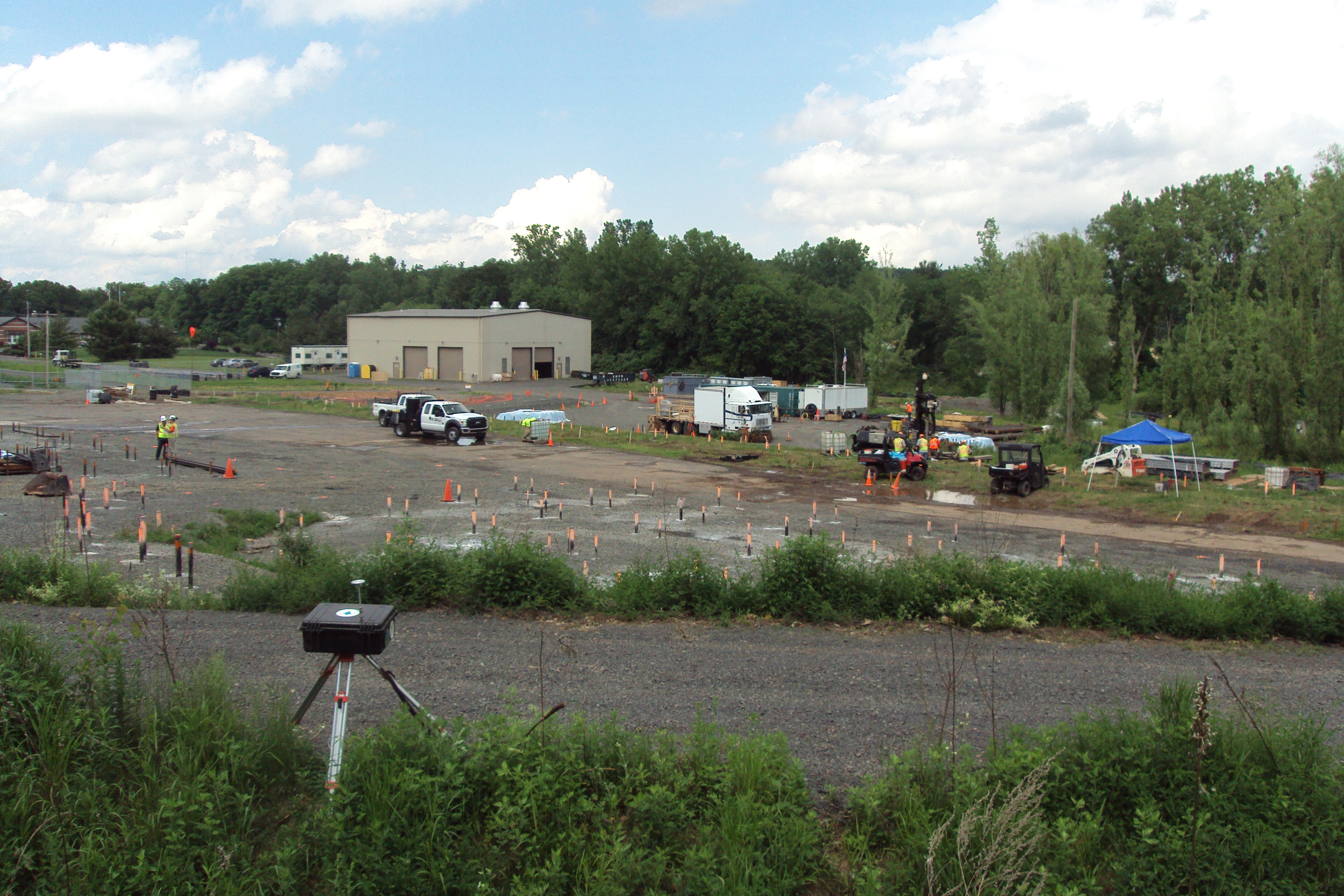

Posted on June 3rd, 2013

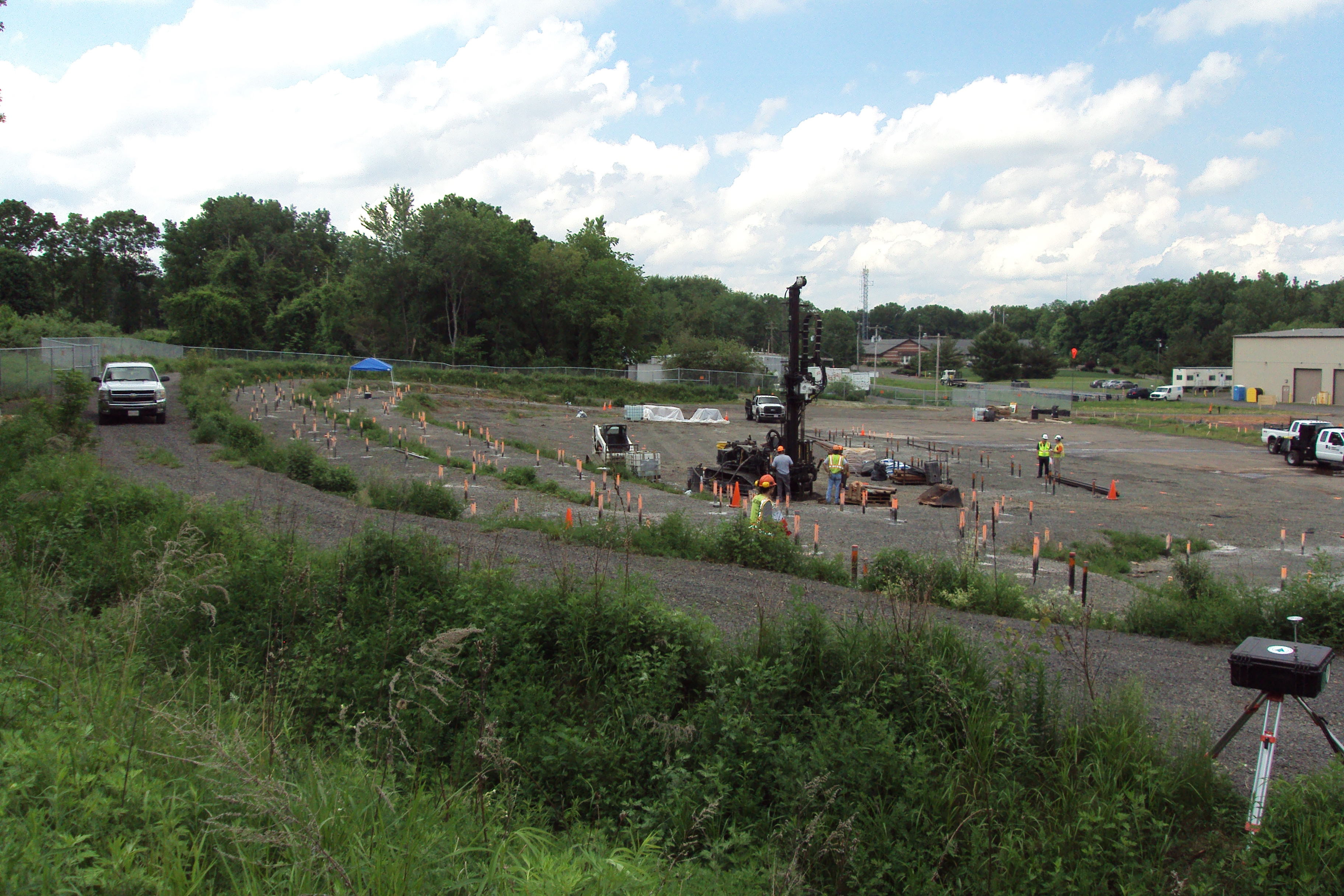

![6-3-13-2](https://www.srsnesite.com/wp-content/uploads/2013/06/6-3-13-2-1024x682.jpg)
Views from southwest looking to the northeast.
It has now been over one month of drilling and installation of the in-situ thermal remediation wells. The team is working hard and doing a great job and currently on schedule. Again, one can see the well pairs, which consist of an electrically powered heater well and a vapor extraction well. Installed to date: 201 Heater Wells (HO), 199 Vapor Extraction Wells (VEW), 25 Temperature Monitoring Points (TMP), and 20 Pressure Monitoring Points (PMP).
Drilling Continues
Posted on May 13th, 2013

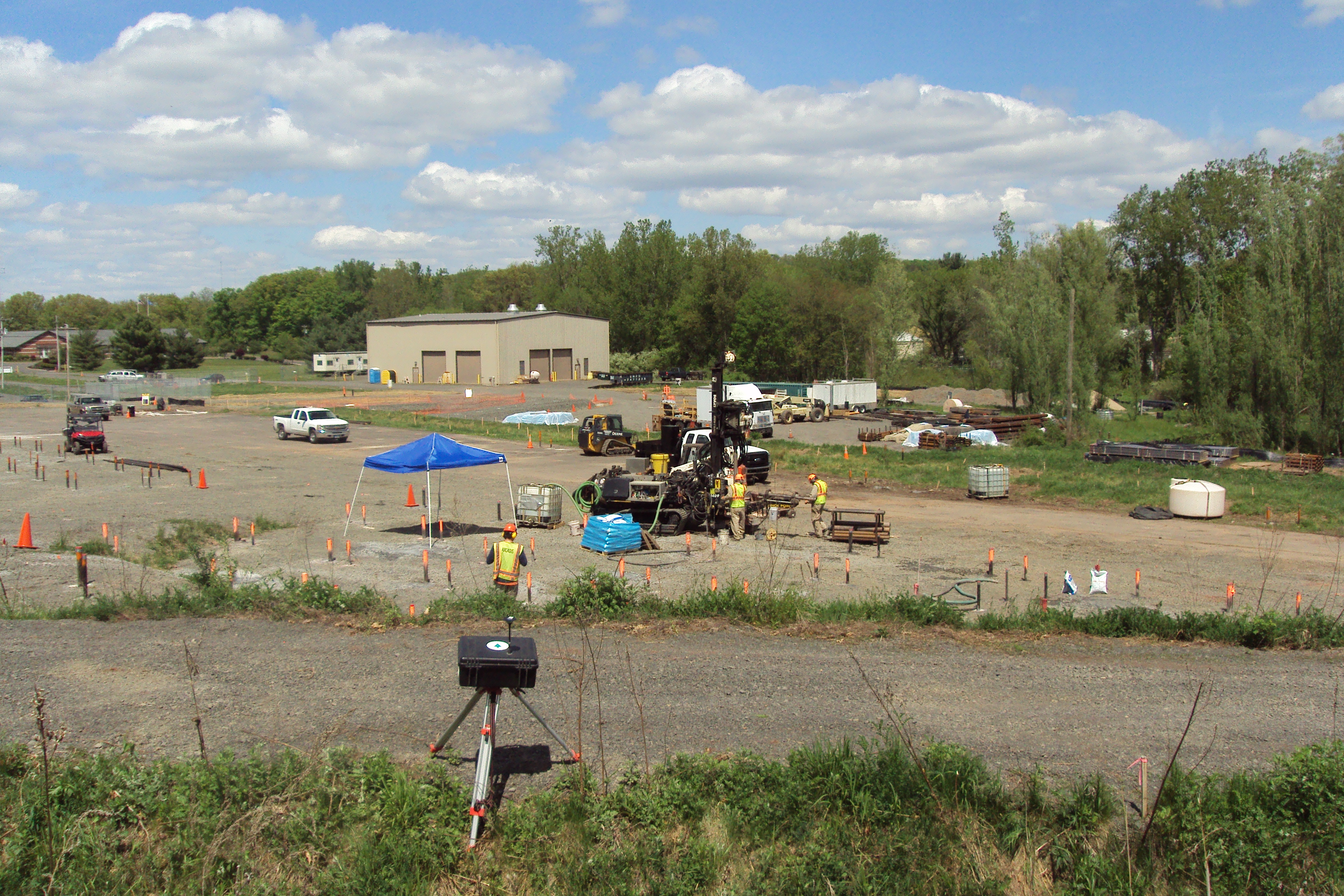

![5-13-13-1](https://www.srsnesite.com/wp-content/uploads/2013/06/5-13-13-1-1024x682.jpg)
View from southwest looking to the northeast.
Drilling continues. The vapor extraction wells are located approximately 3 feet from the electrically powered heater wells. In addition the team is installing Temperature Monitoring Points and Pressure Monitoring Points. To date we’ve installed: 109 Heater Wells (HO), 105 Vapor Extraction Wells (VEW), 9 Temperature Monitoring Points (TMP), and 9 Pressure Monitoring Points (PMP). Also, note the air monitor in the foreground.
In-situ Thermal Remediation – Drilling Begins
Posted on April 26th, 2013

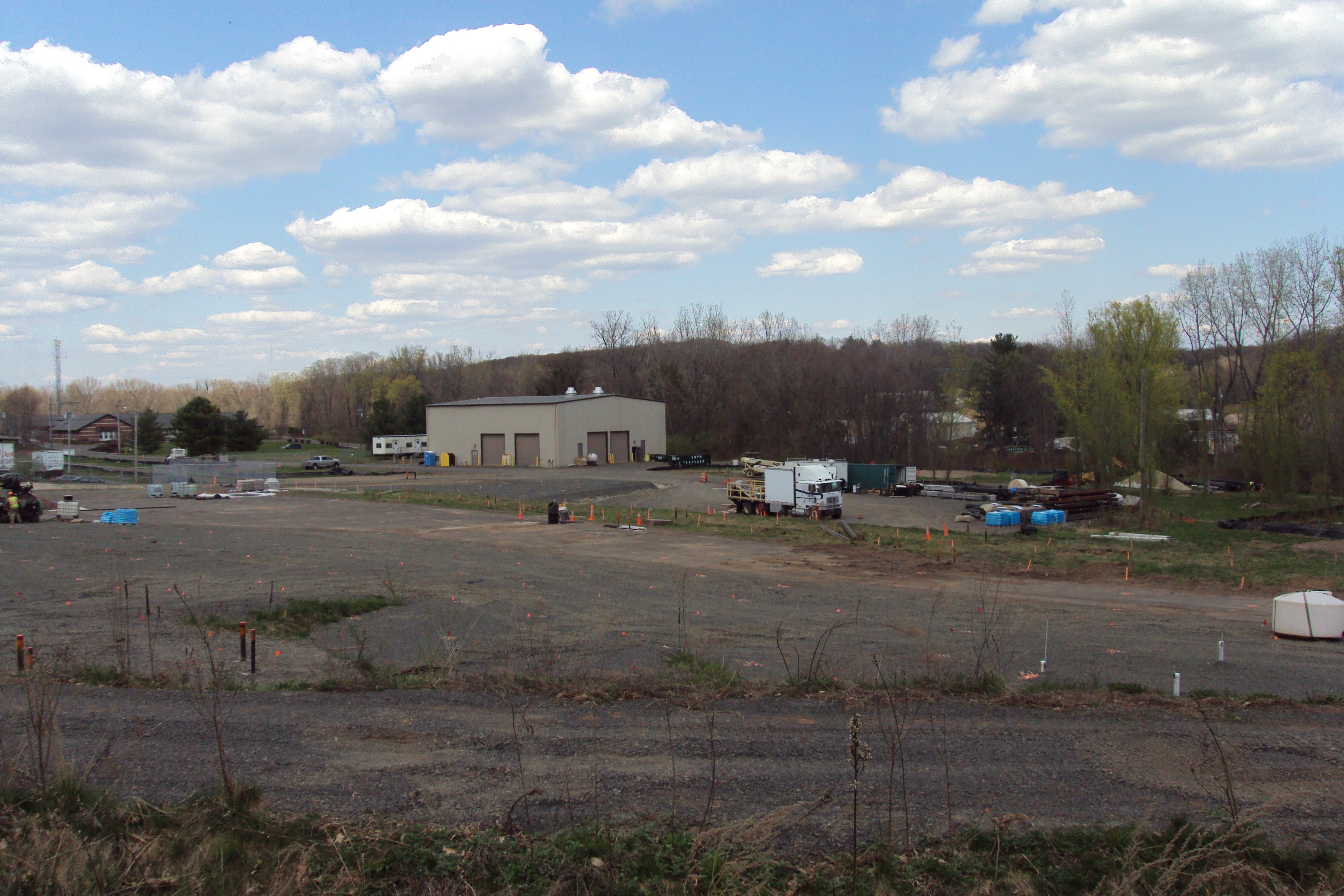

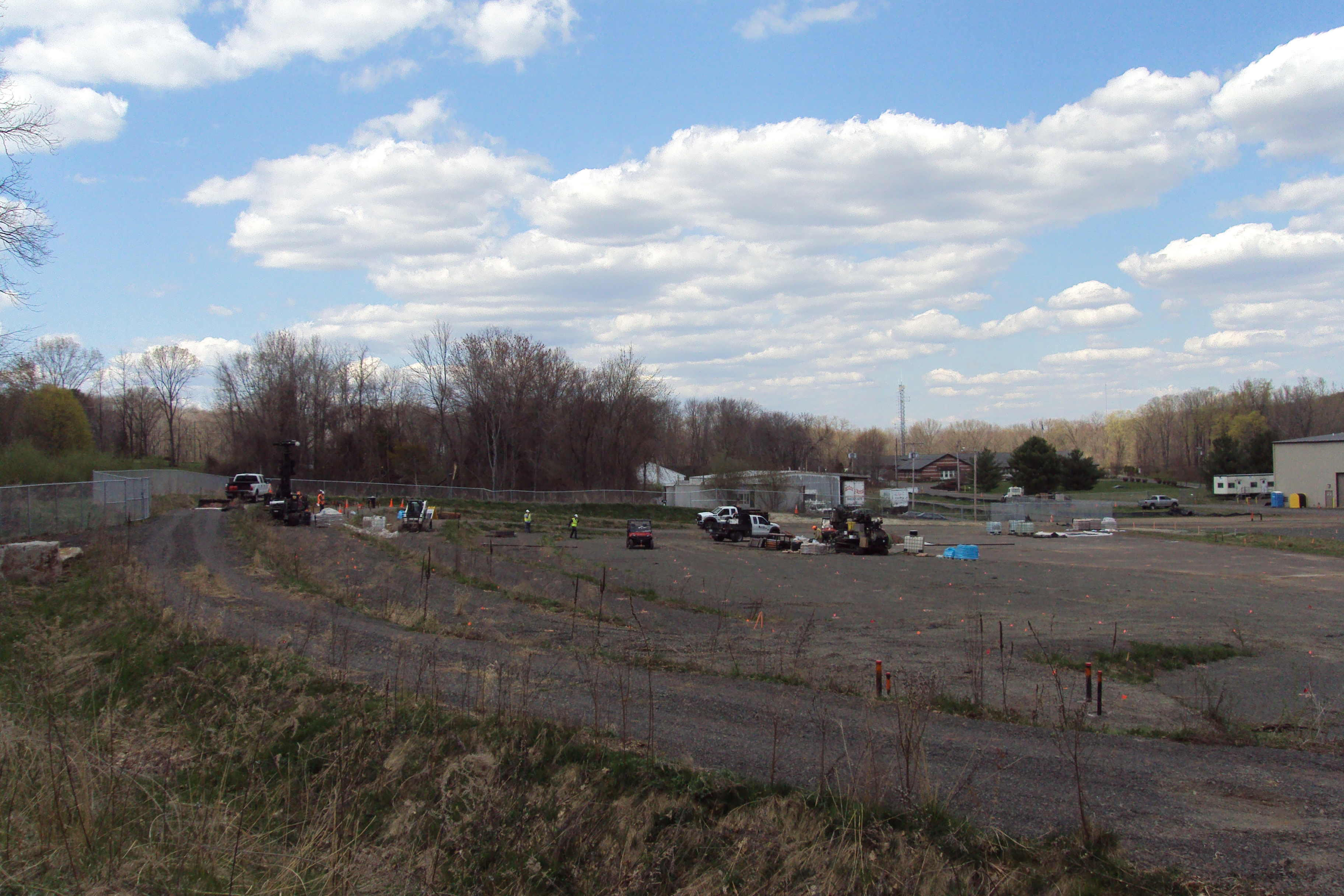

![4-26-13-2](https://www.srsnesite.com/wp-content/uploads/2013/06/4-26-13-2-300x200.jpg)
![4-26-13-1](https://www.srsnesite.com/wp-content/uploads/2013/06/4-26-13-1-300x200.jpg)
Views from southwest looking to the northeast.
Boart Longyear begins drilling in-situ thermal remediation (ISTR) wells, which consist of electrically powered heater wells and vapor extraction wells. Installed to date: 24 Heater Wells (HO), 24 Vapor Extraction Wells (VEW), 1 Temperature Monitoring Point (TMP), and 1 Pressure Monitoring Point (PMP).
In-situ Thermal Remediation System Proposed Wellfield

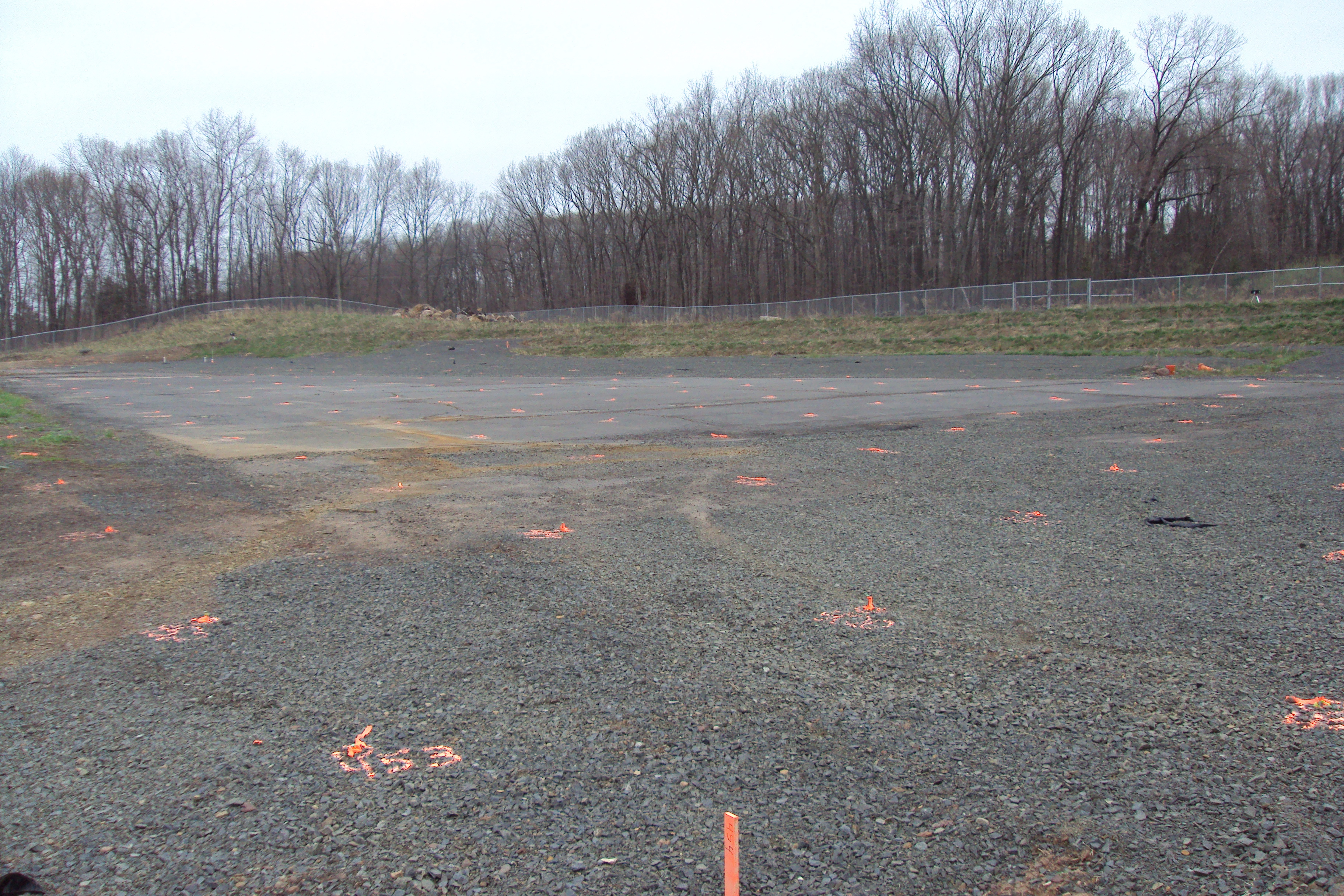

Posted on April 23rd, 2013
![4-23-13-1](https://www.srsnesite.com/wp-content/uploads/2013/06/4-23-13-1-1024x682.jpg)
View from northeast looking to the southwest showing the proposed in-situ thermal remediation (ISTR) wellfield and thermal treatment zone.
